New project awarded at Sweeden (updated 10/12/24)

On may 6th we started our mobilization to the H2 Green Steel Plant Project in Boden (Sweeden). We were awarded with two double walled API-620 tanks for a total capacity of 4.000 m3
The project will be executed in two phases during 2024 and 2025 to avoid the extreme temperatures of the winter and will mobilize a total of 12 people including our site supervisor, welders for CS and SS, assemblers and helpers.

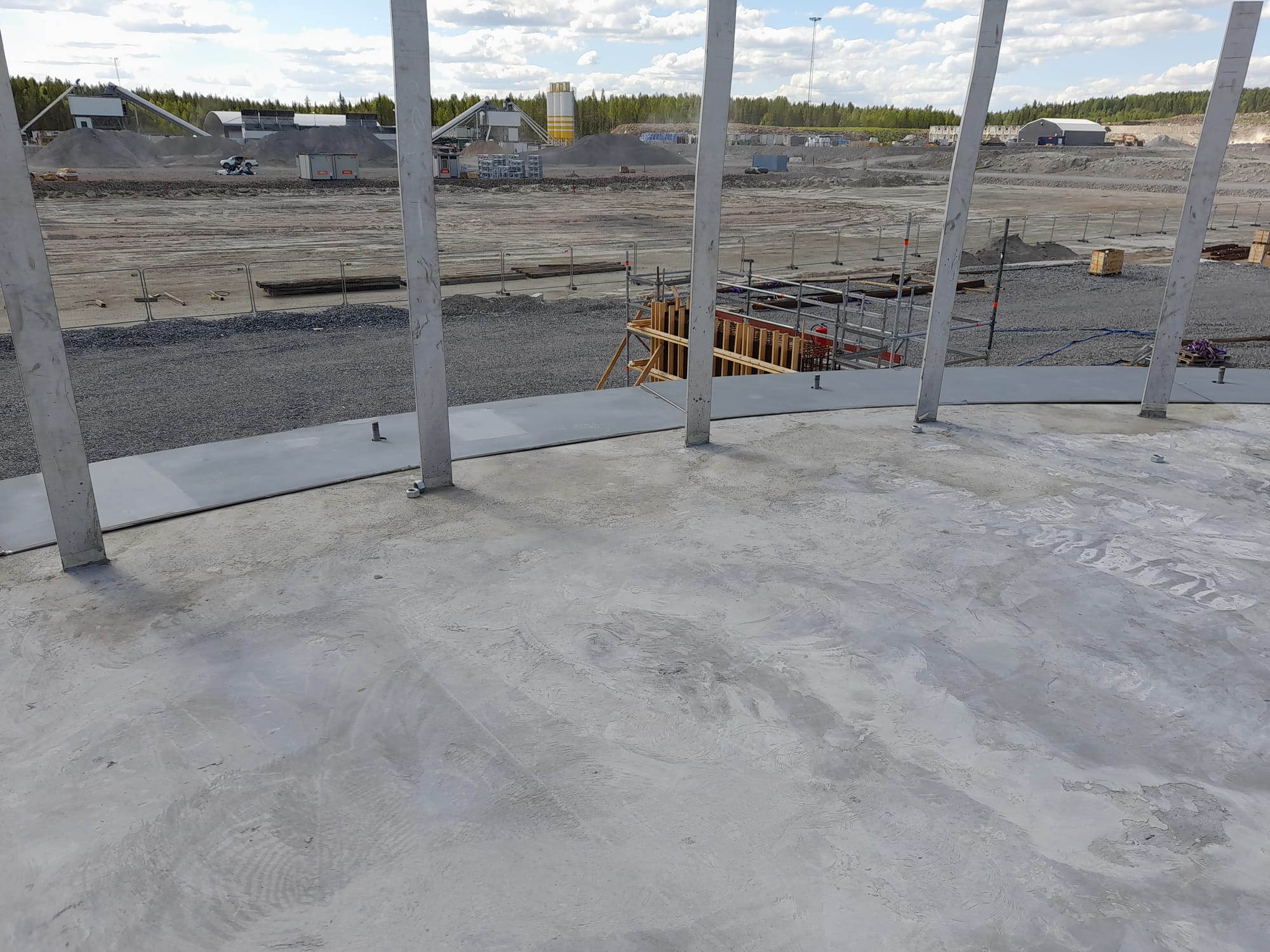

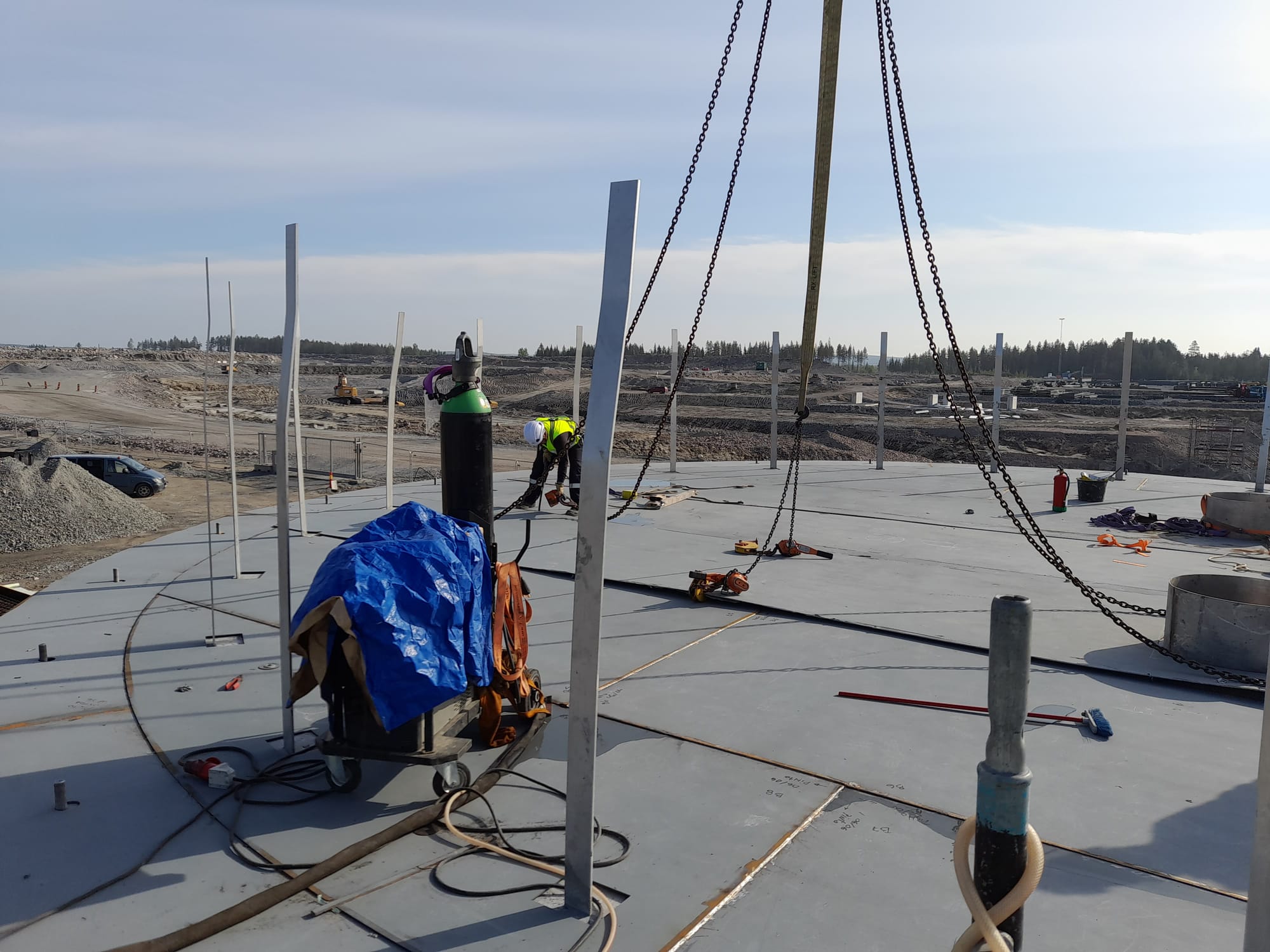

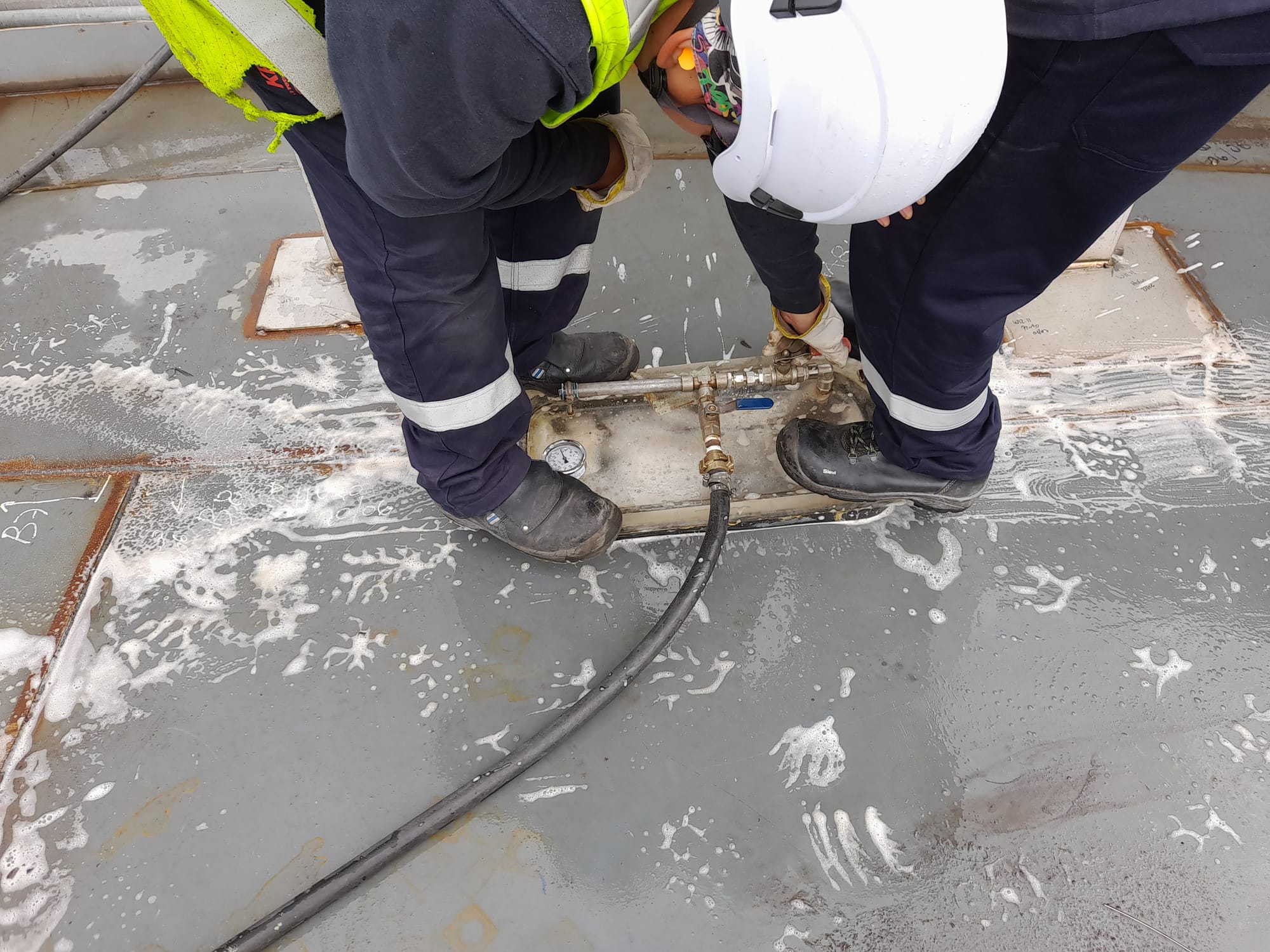

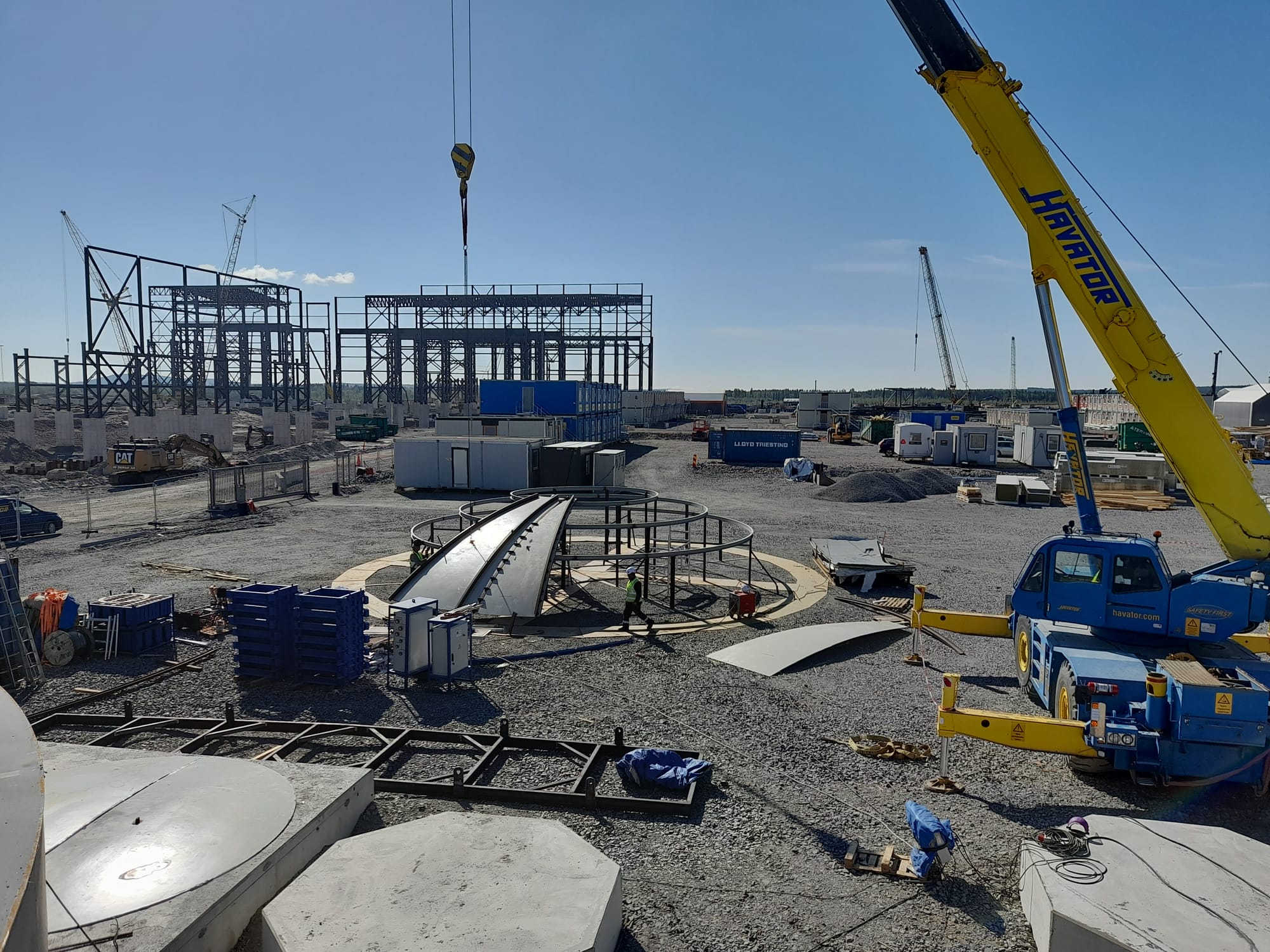

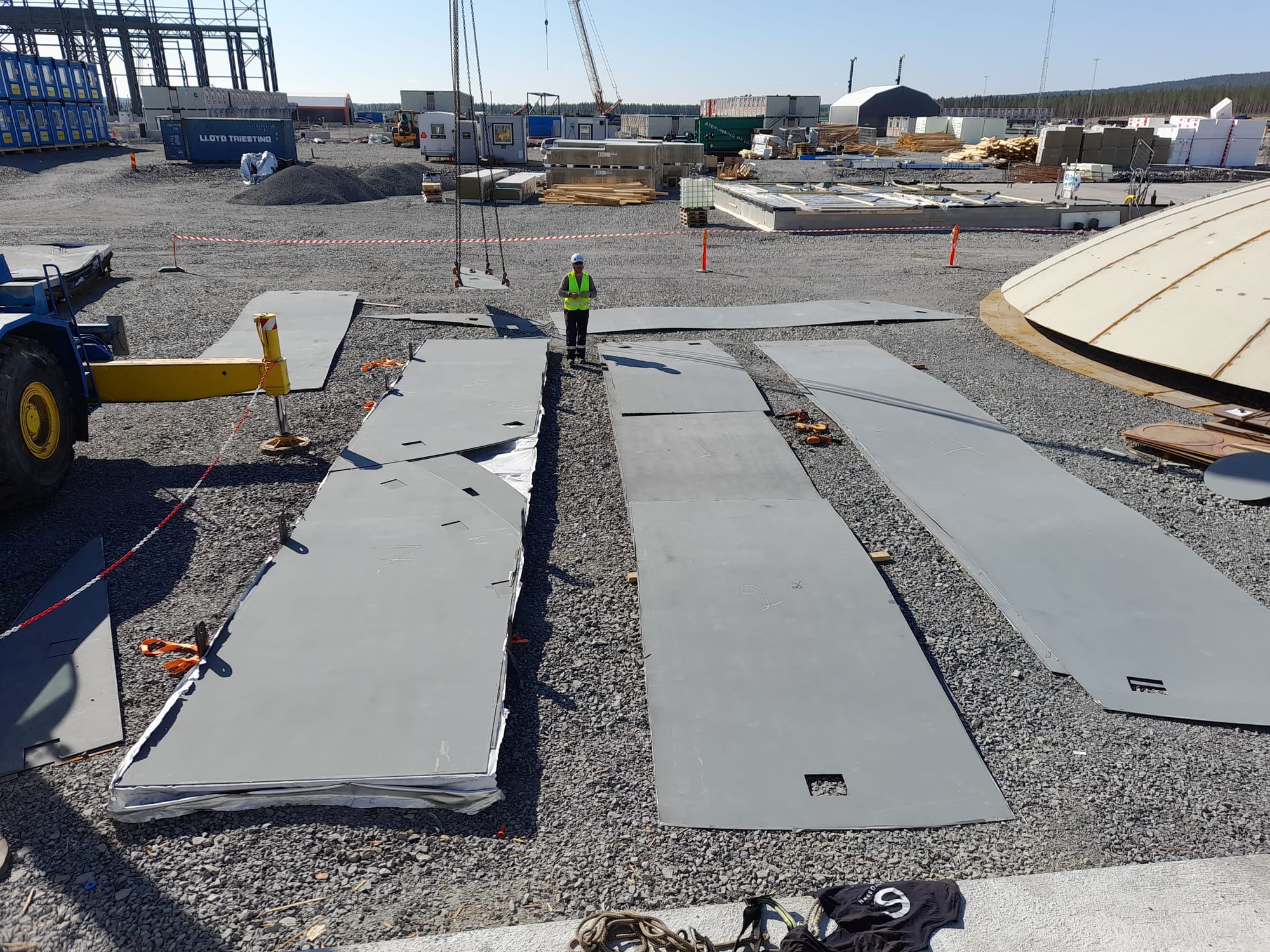

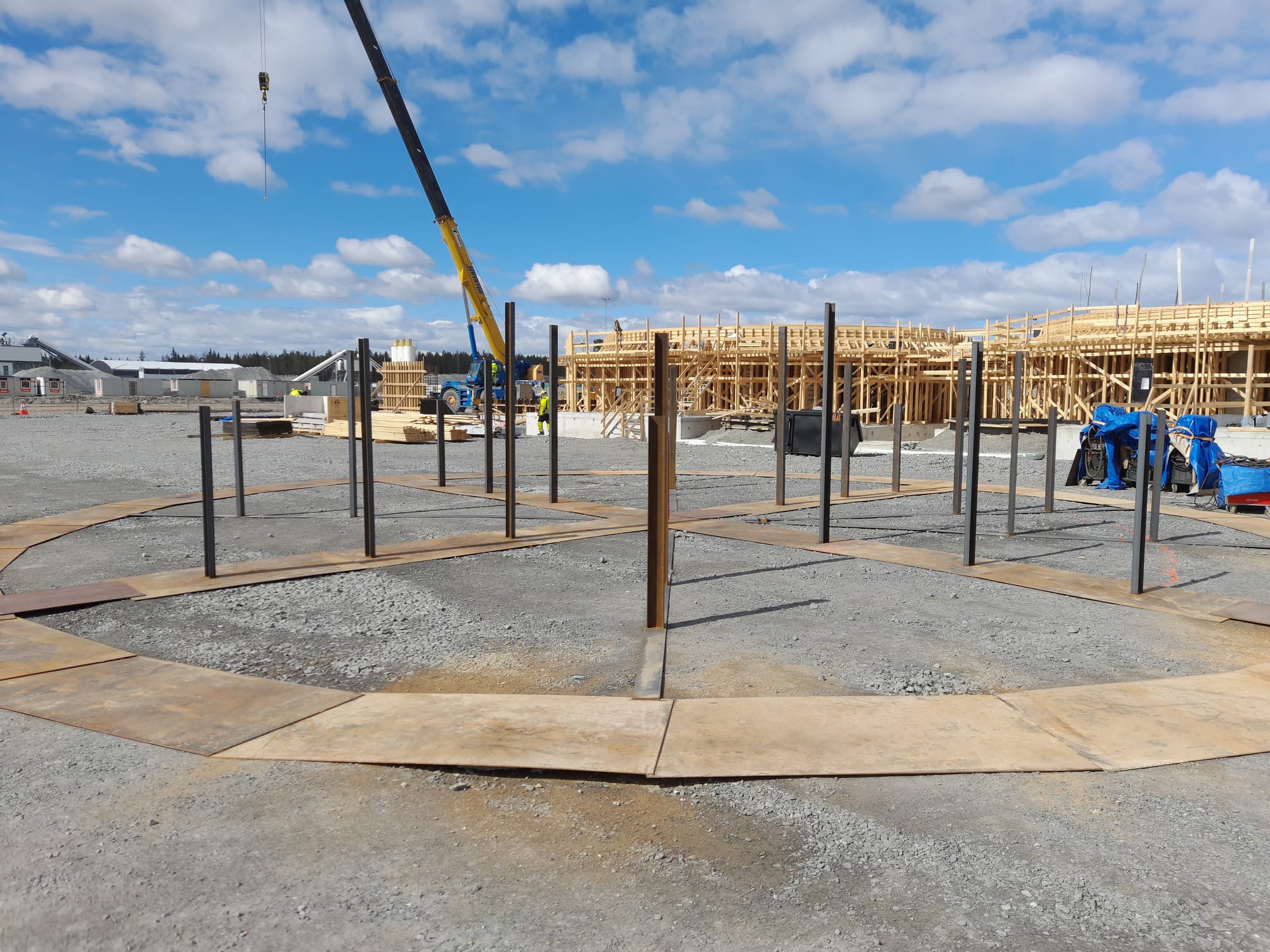

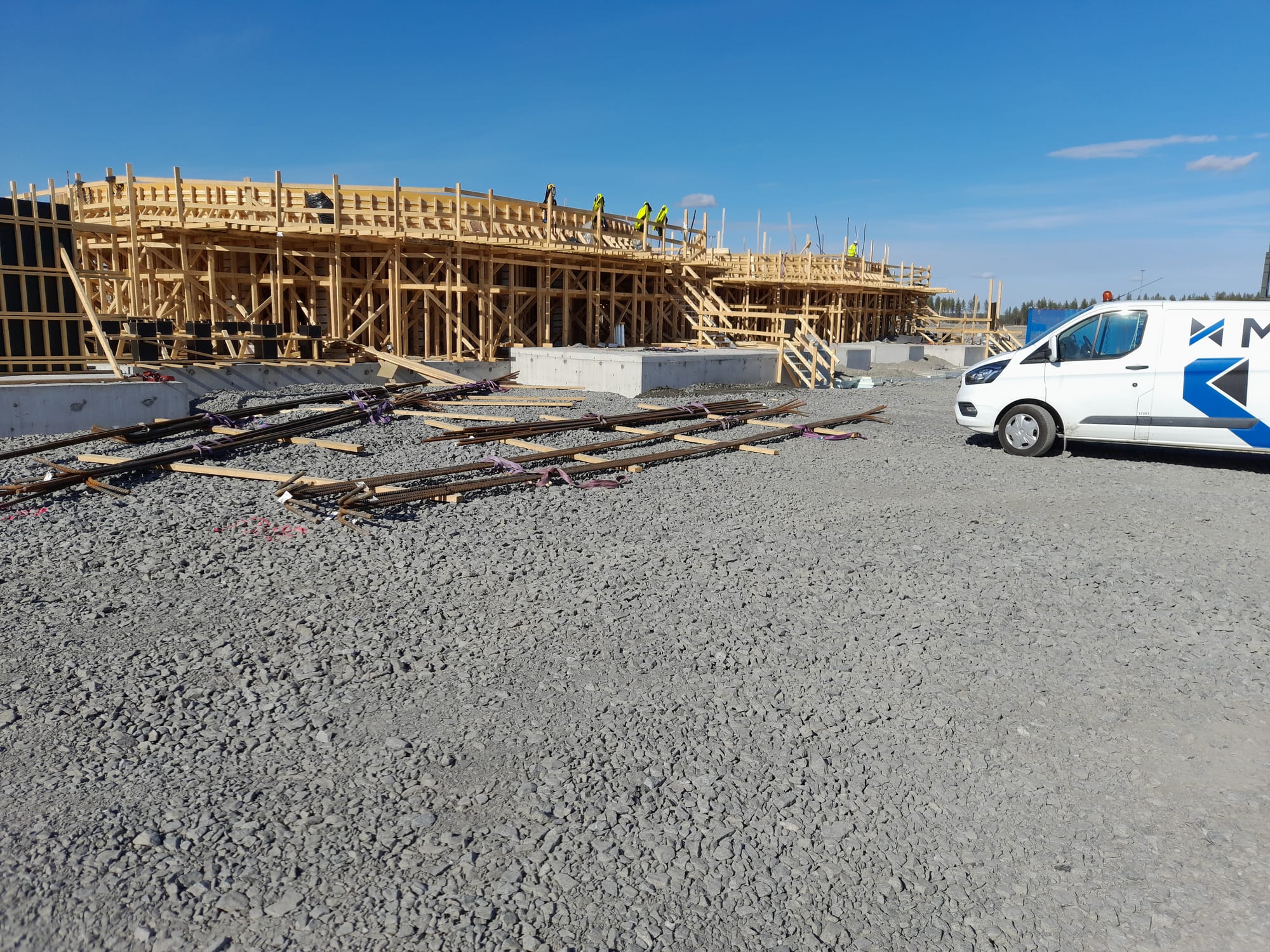

15/06/24 Update

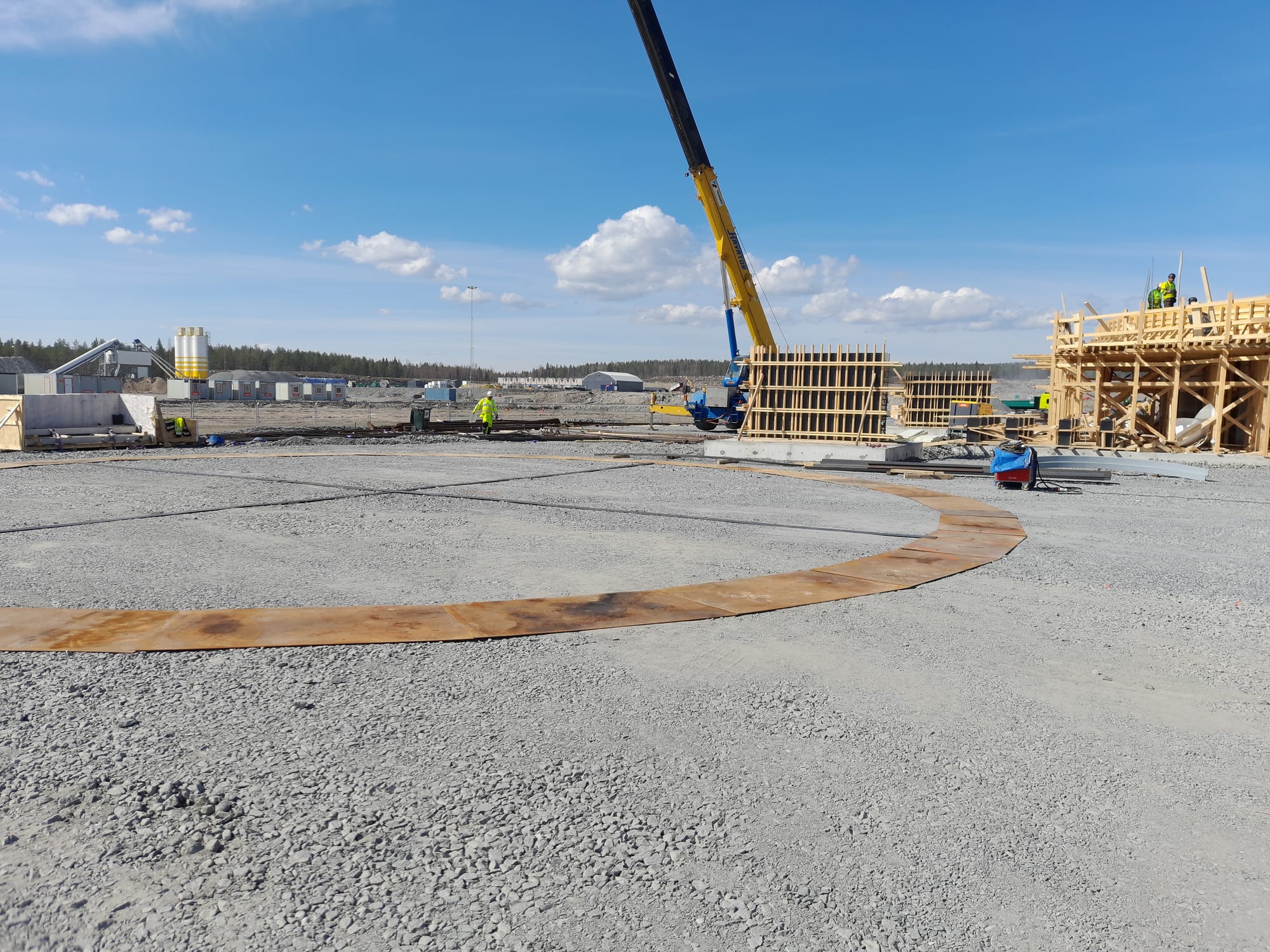

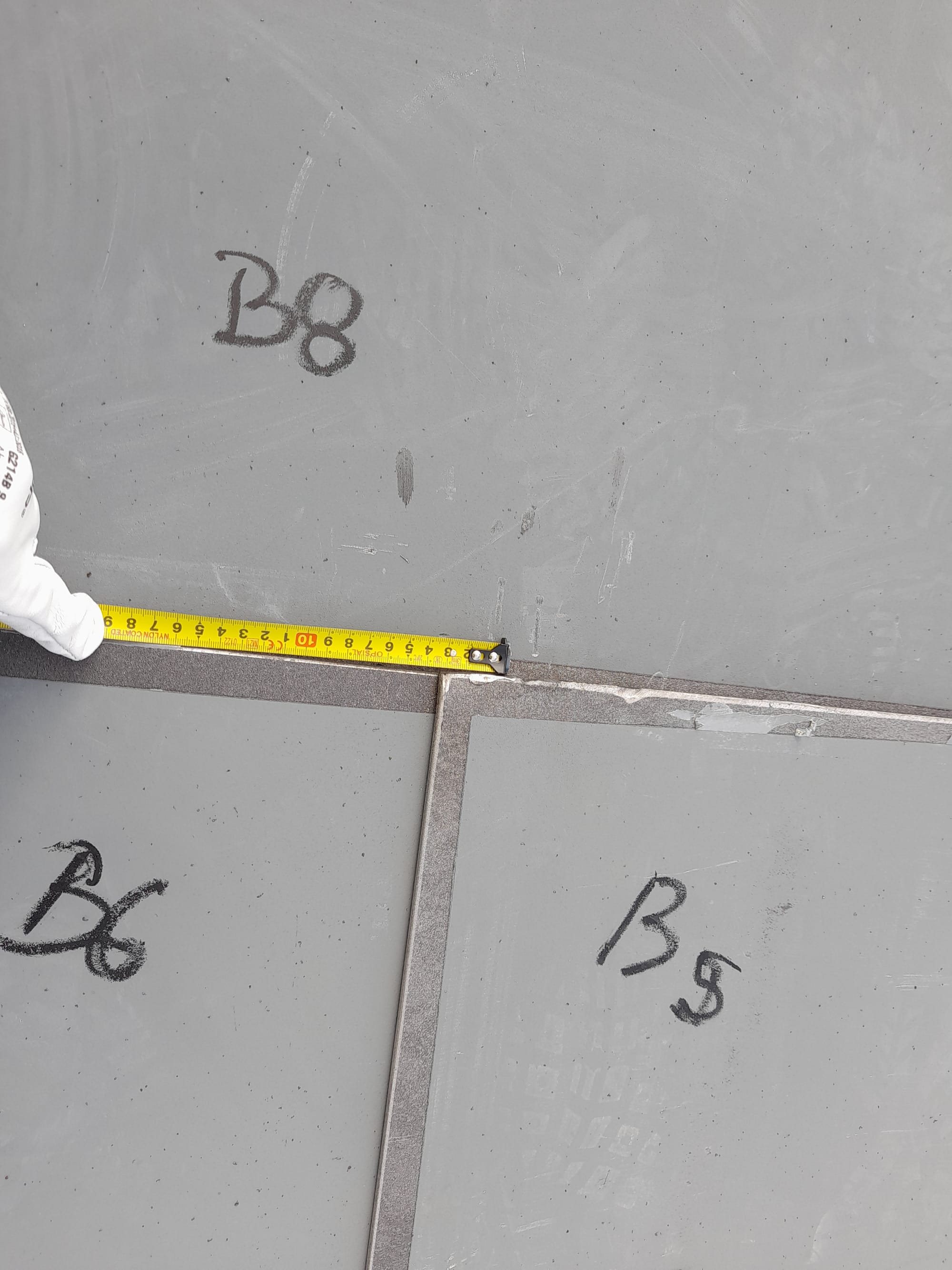

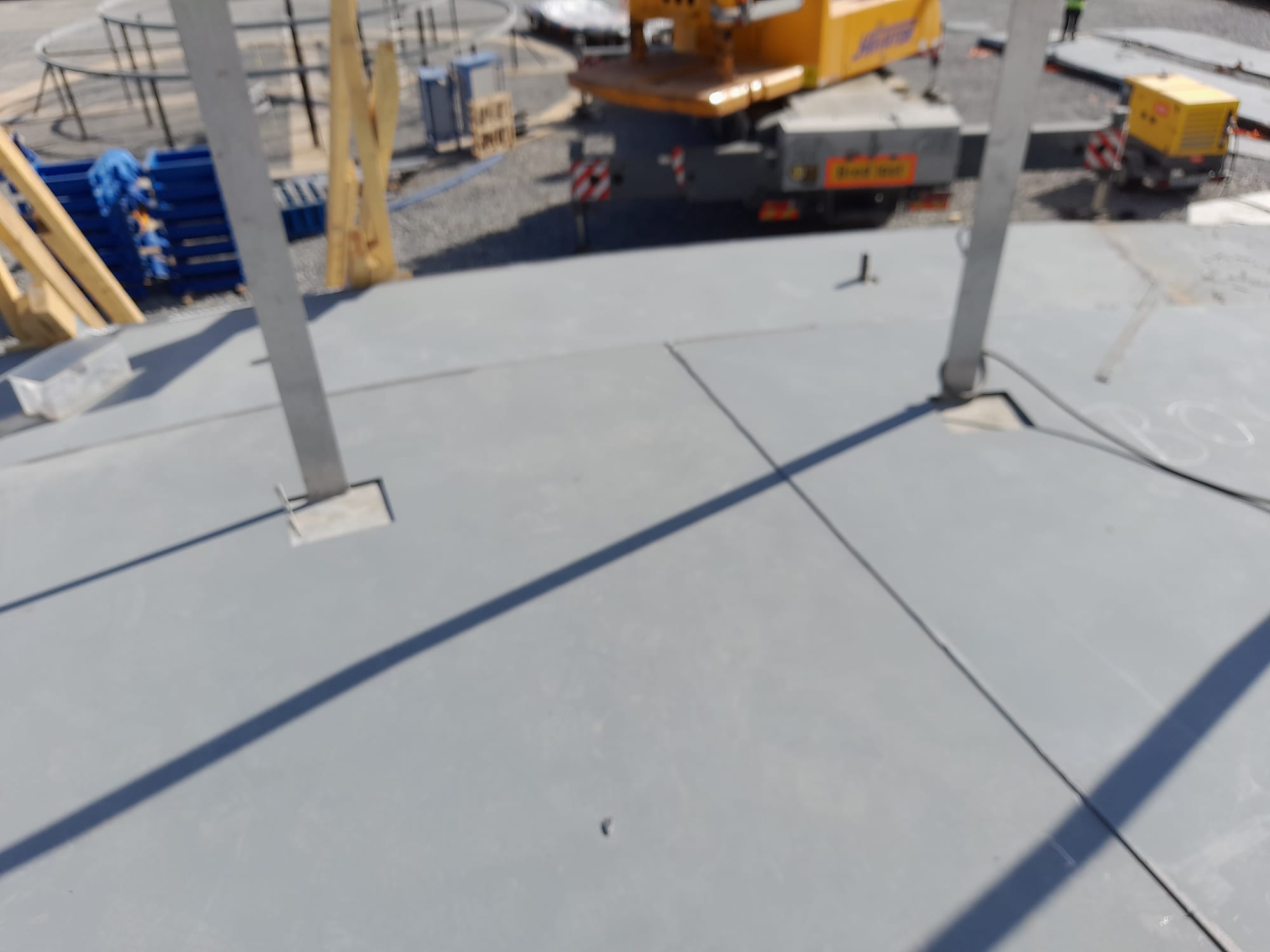

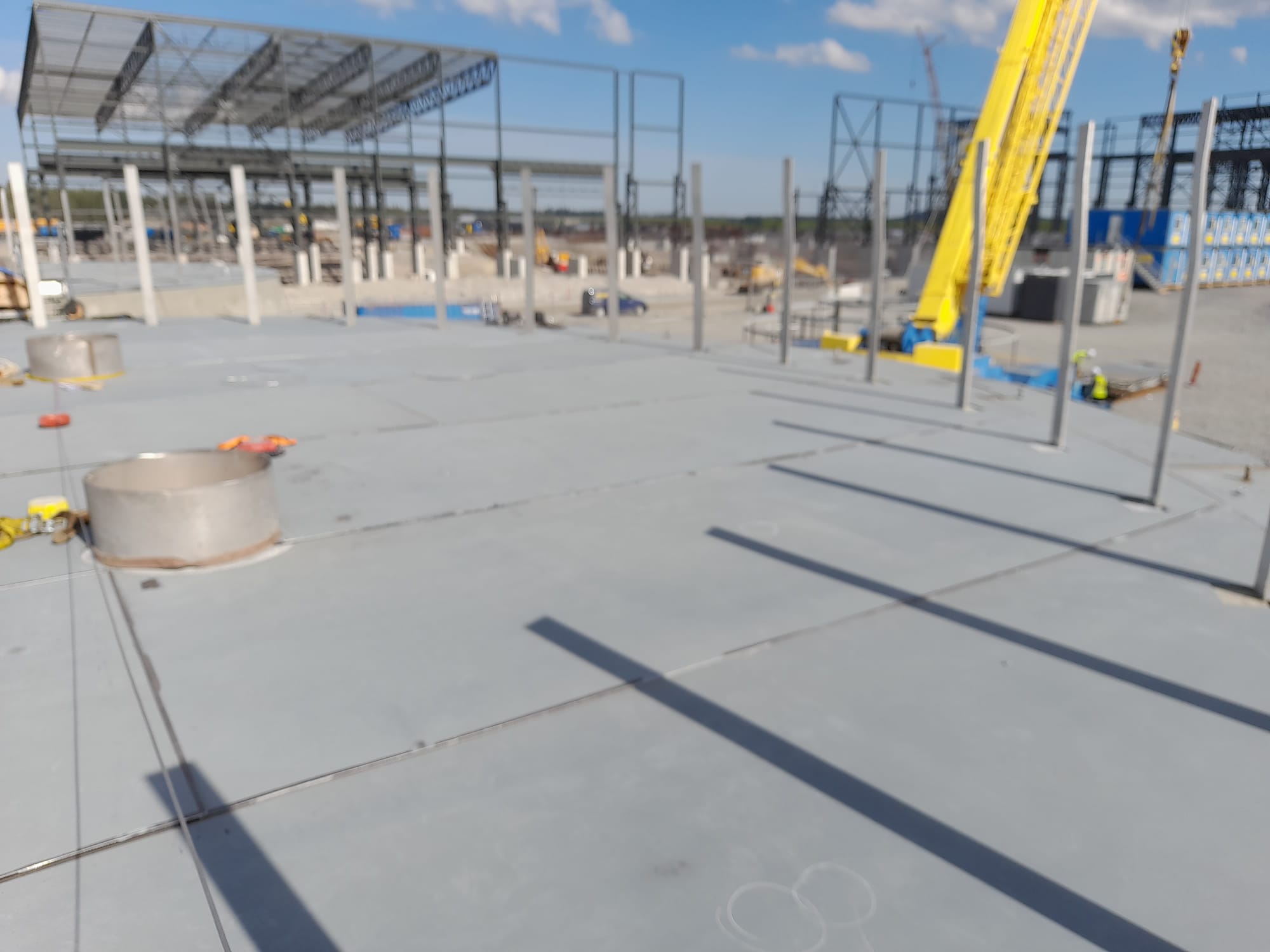

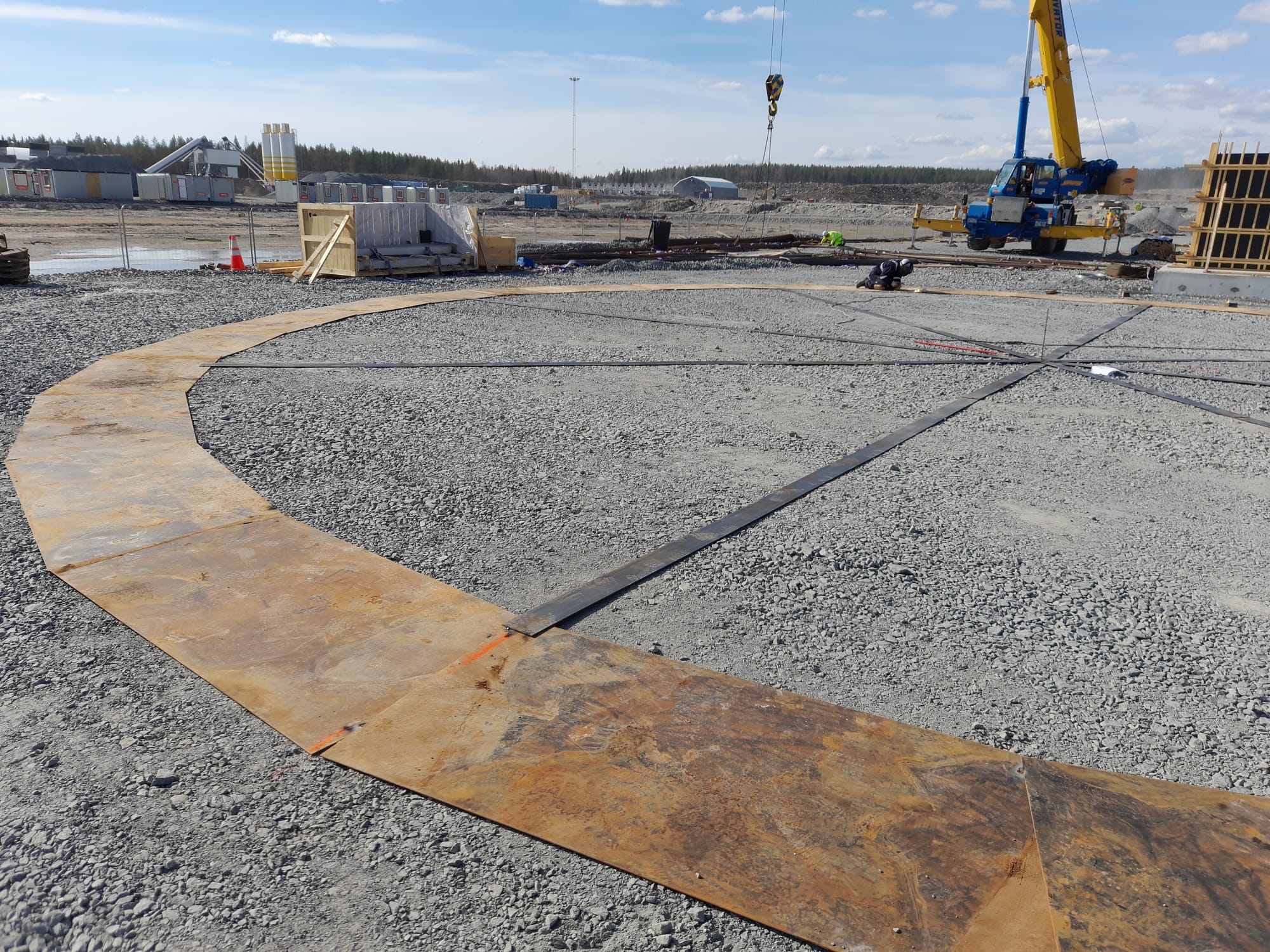

Placement and welding of CS bottoms on the foundation.

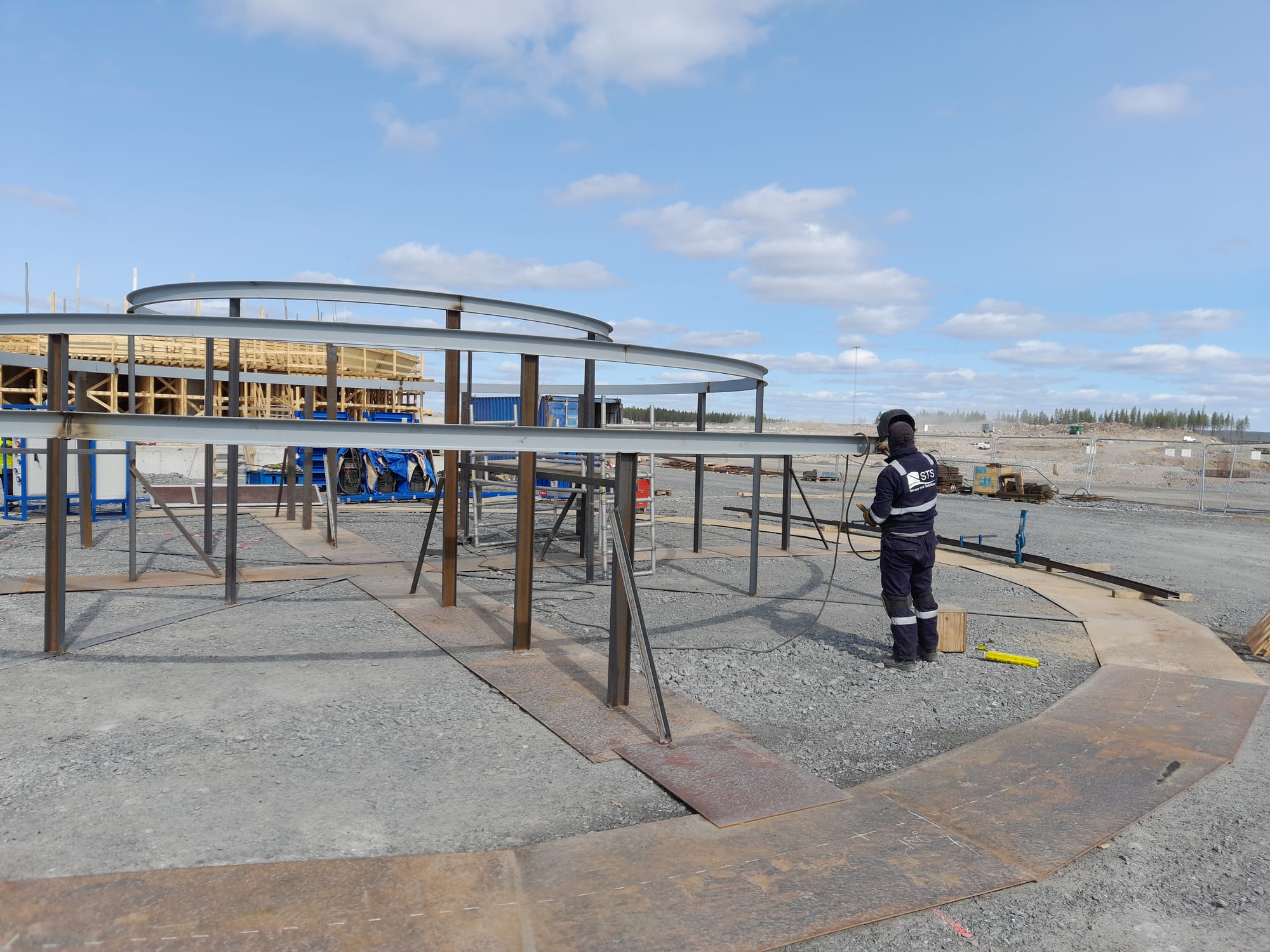

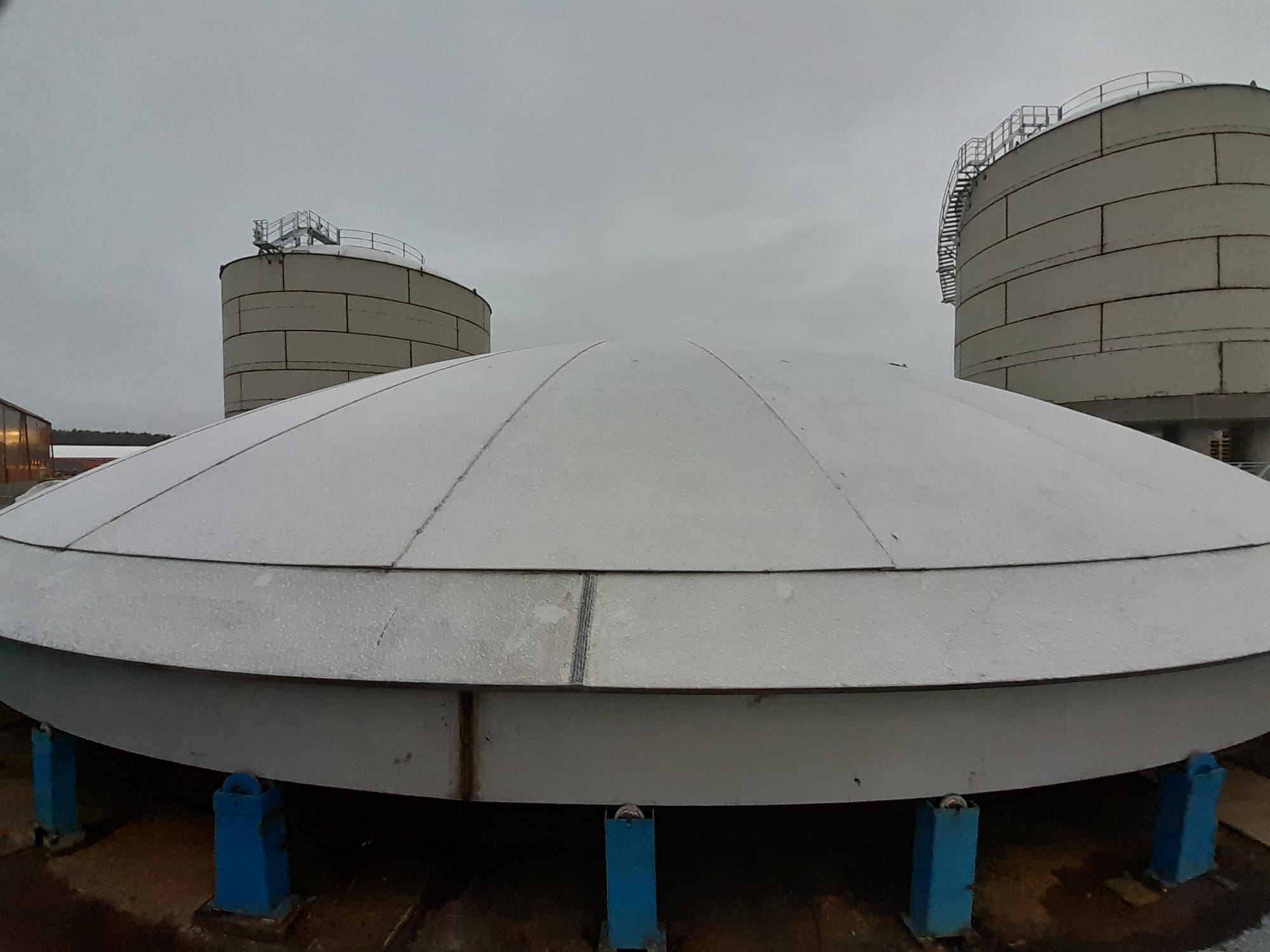

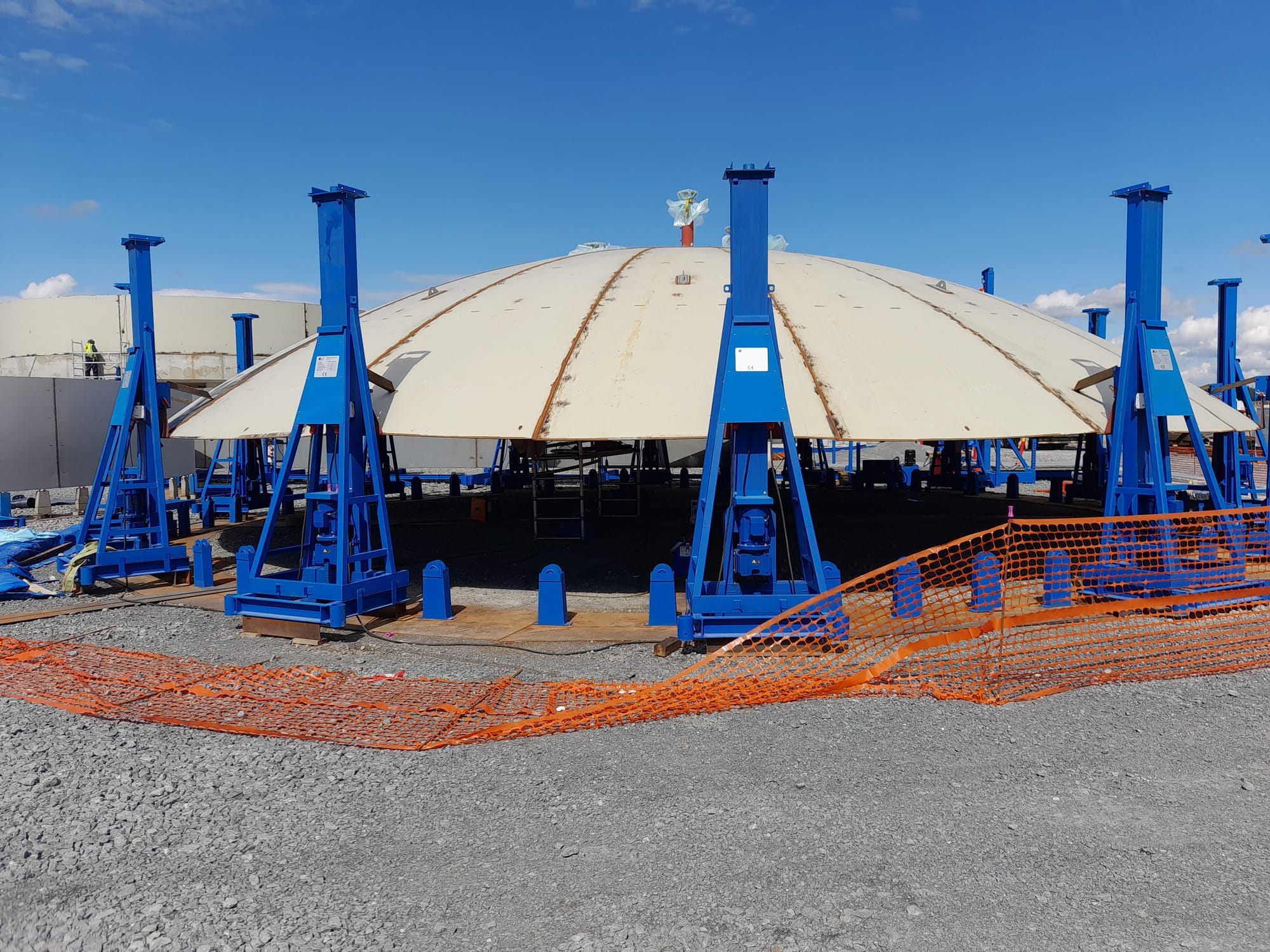

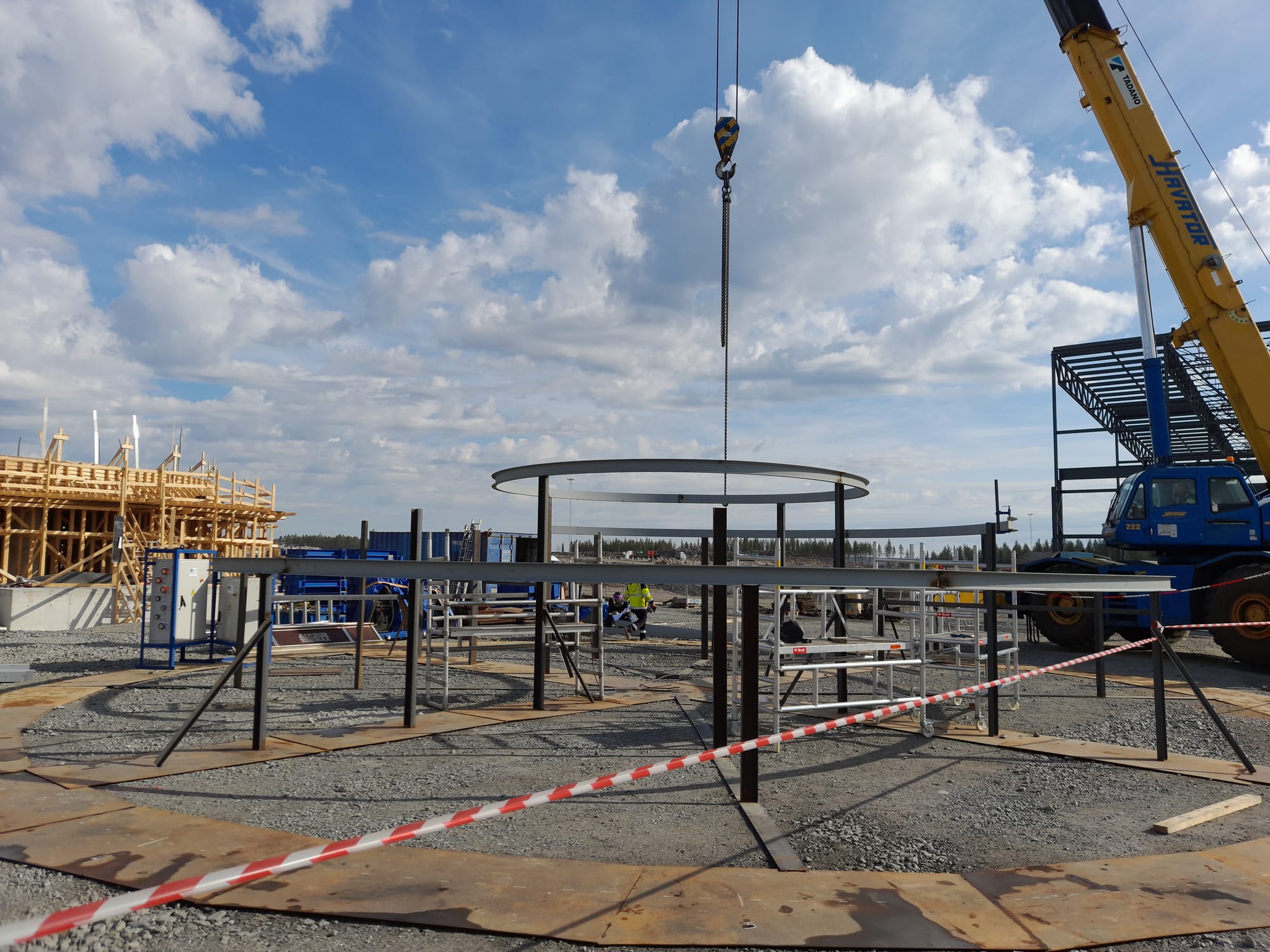

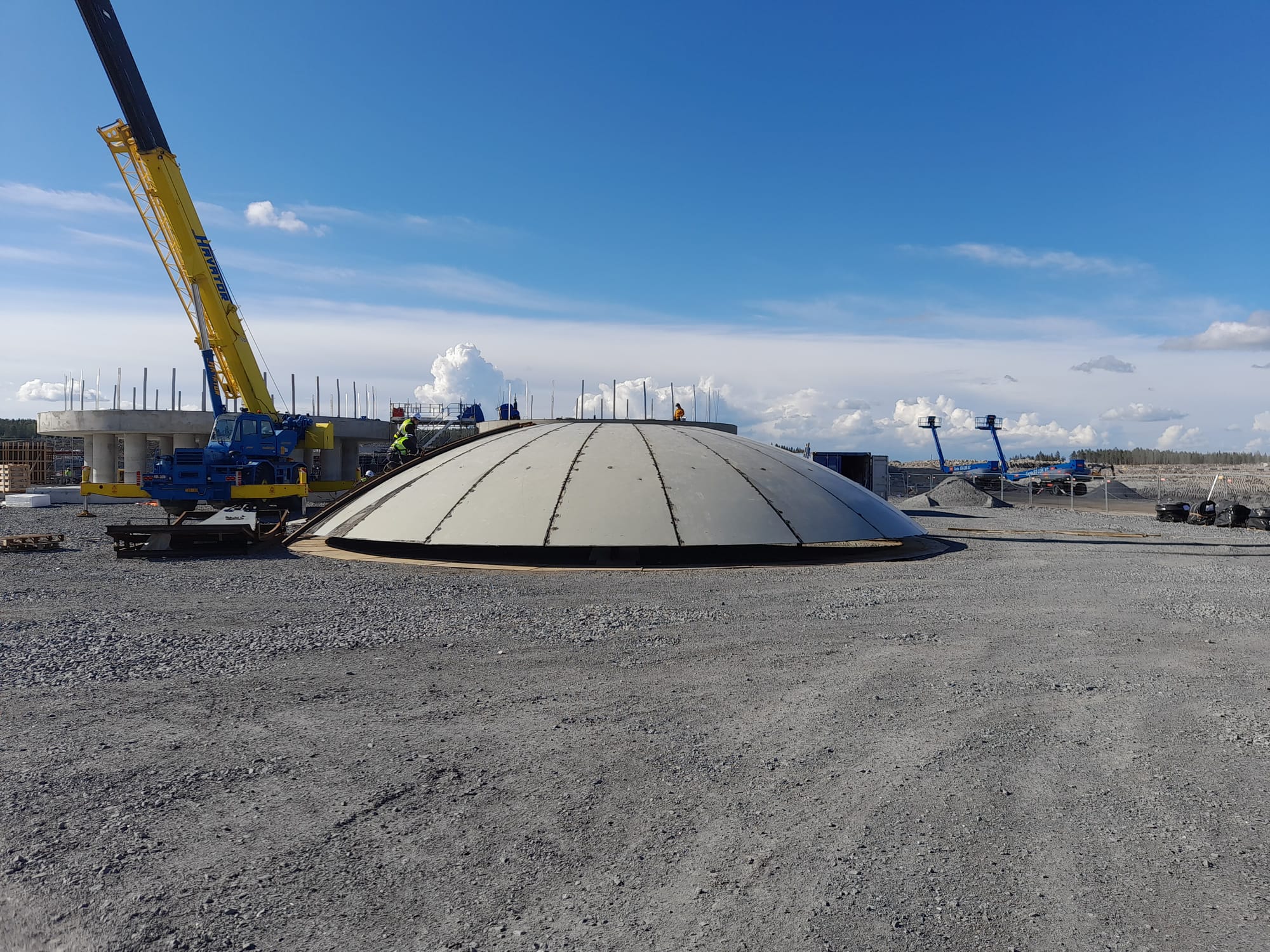

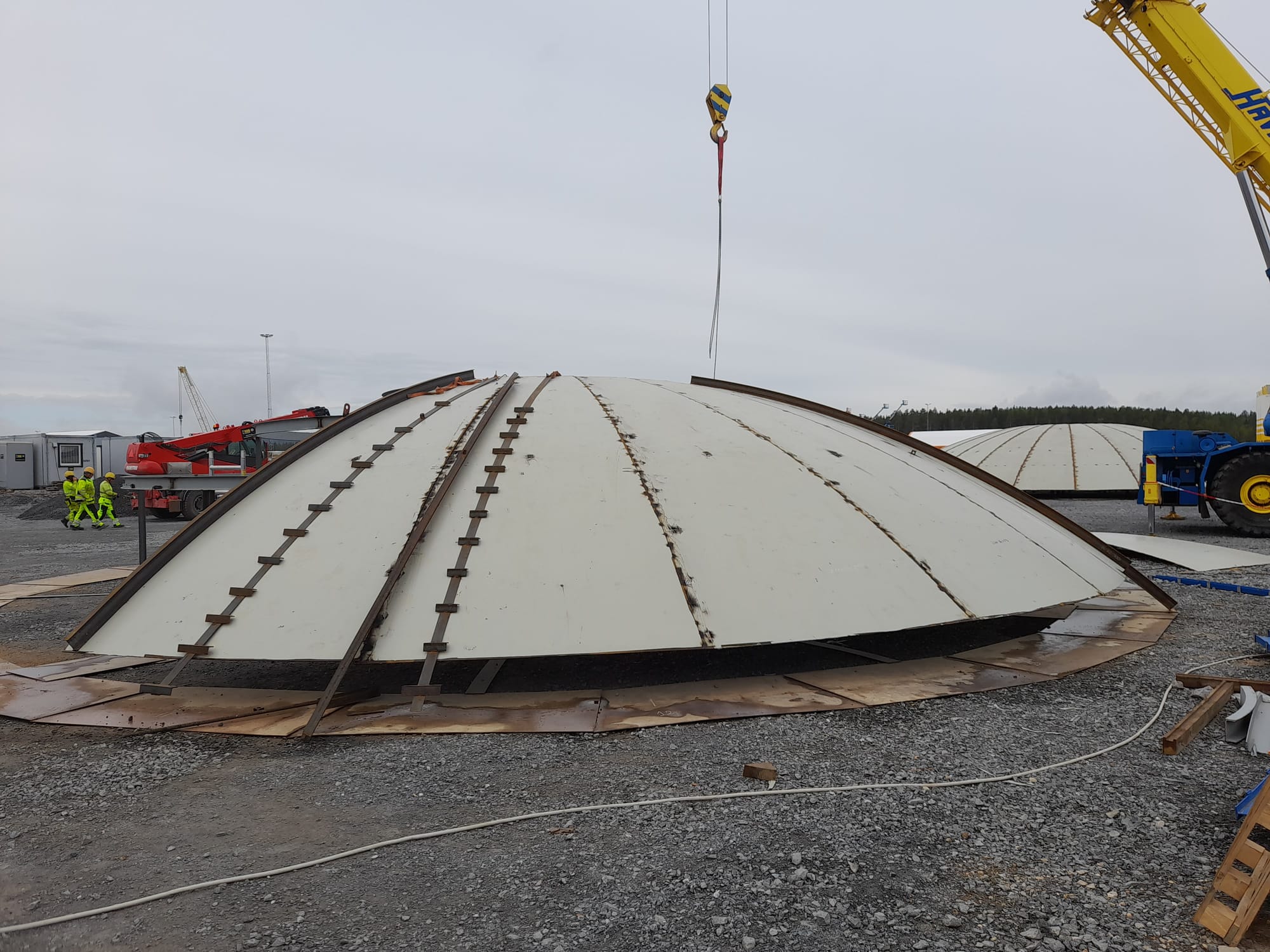

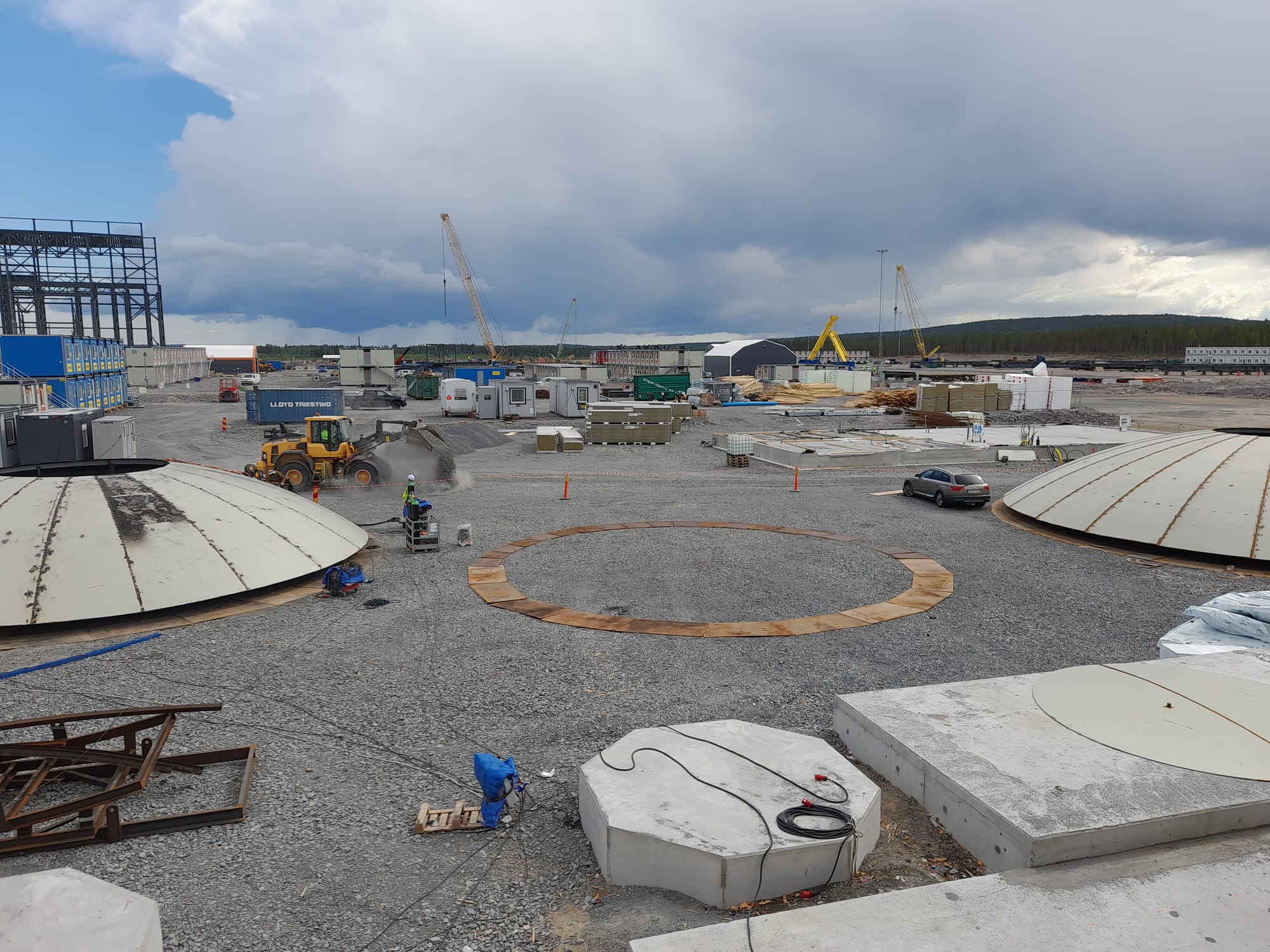

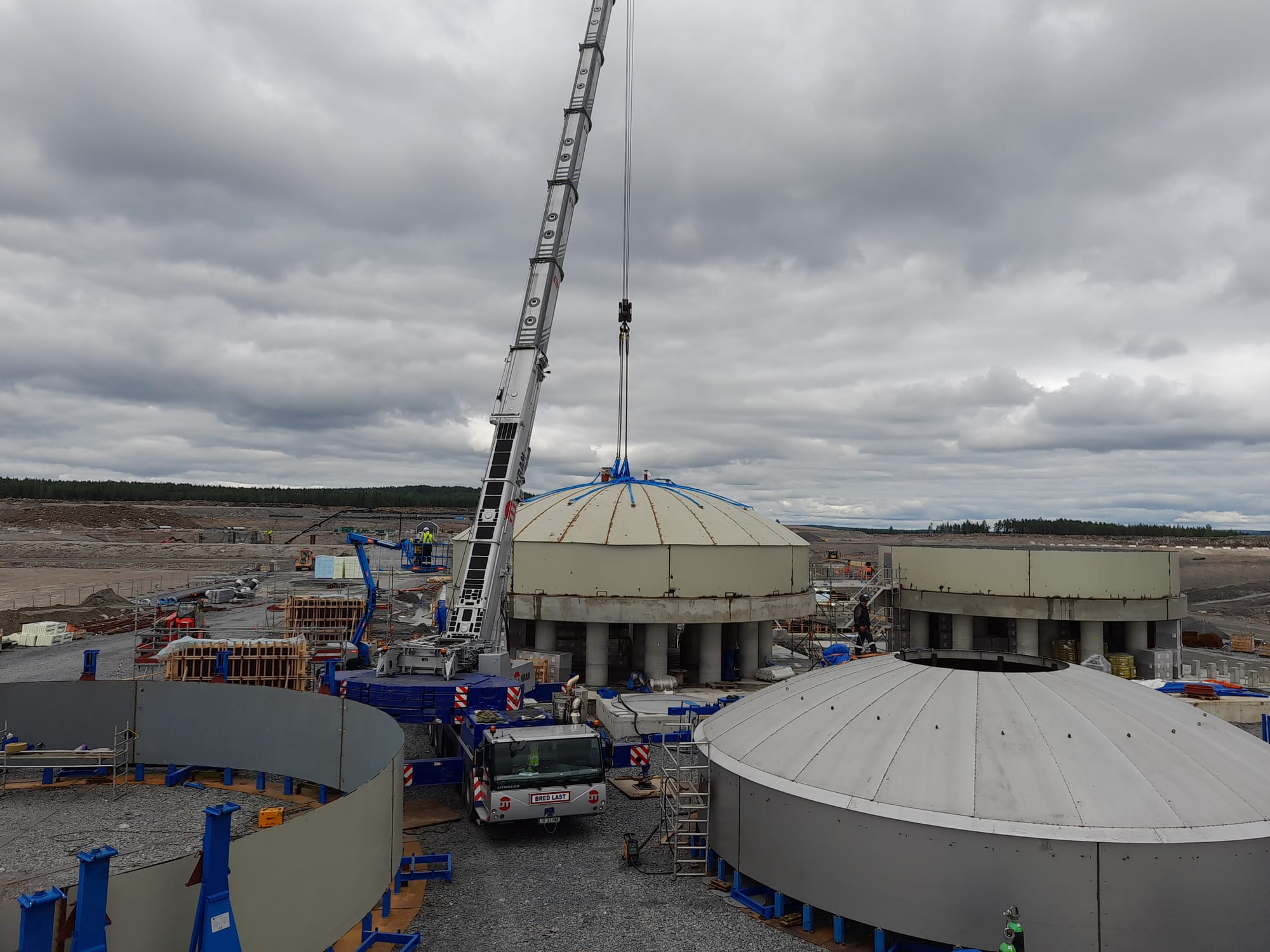

CS Roof asembly on temporary location.

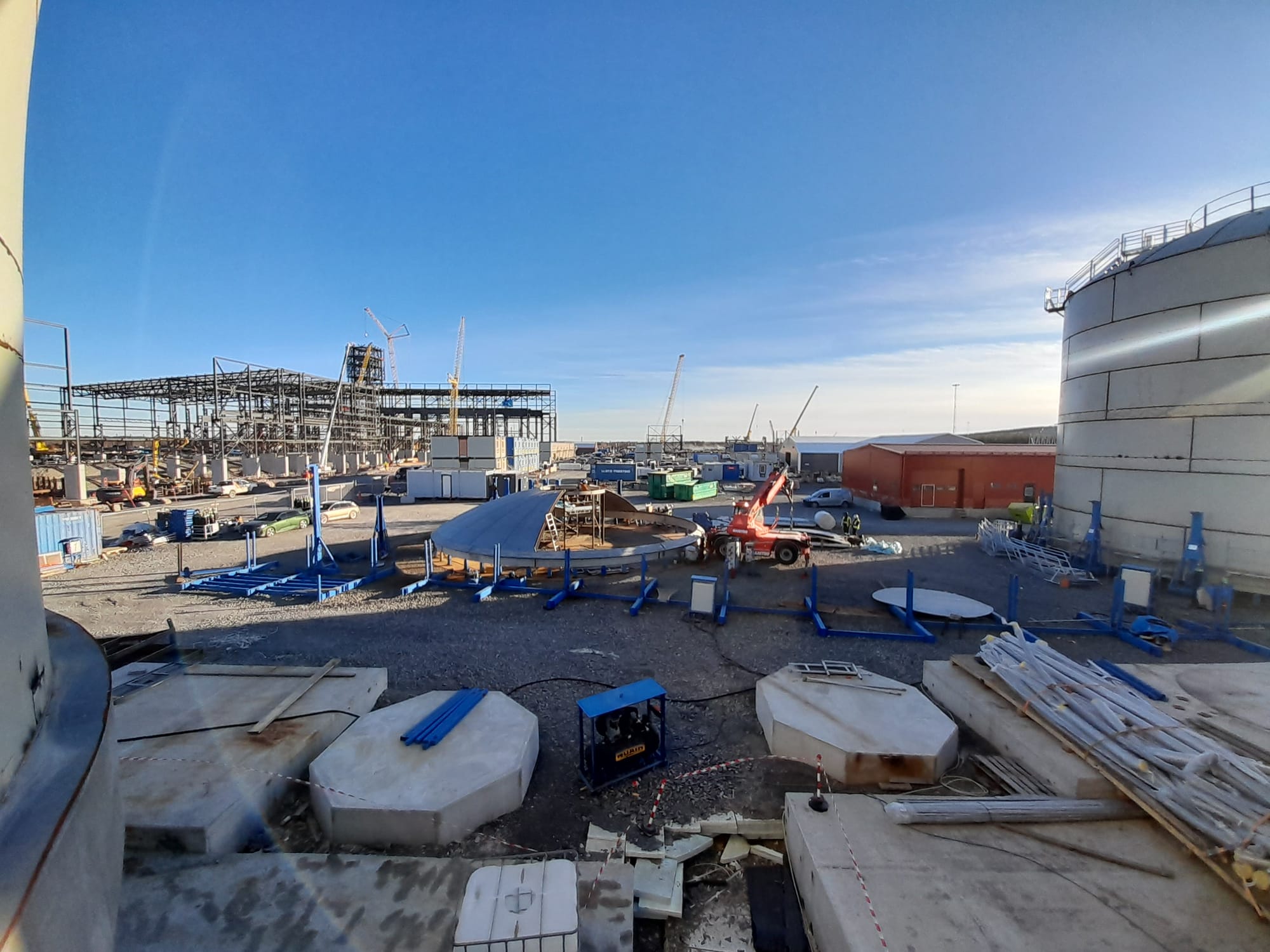

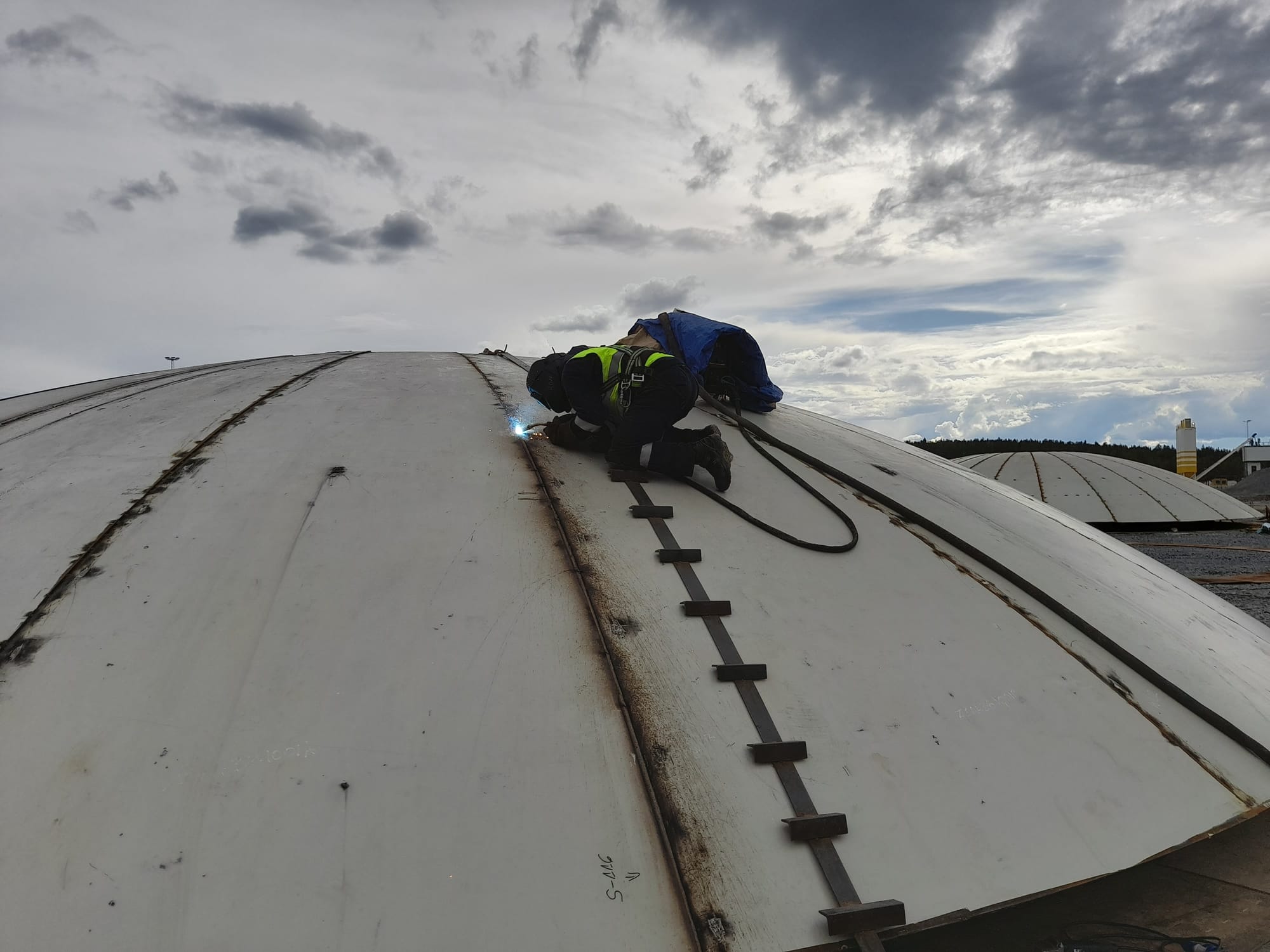

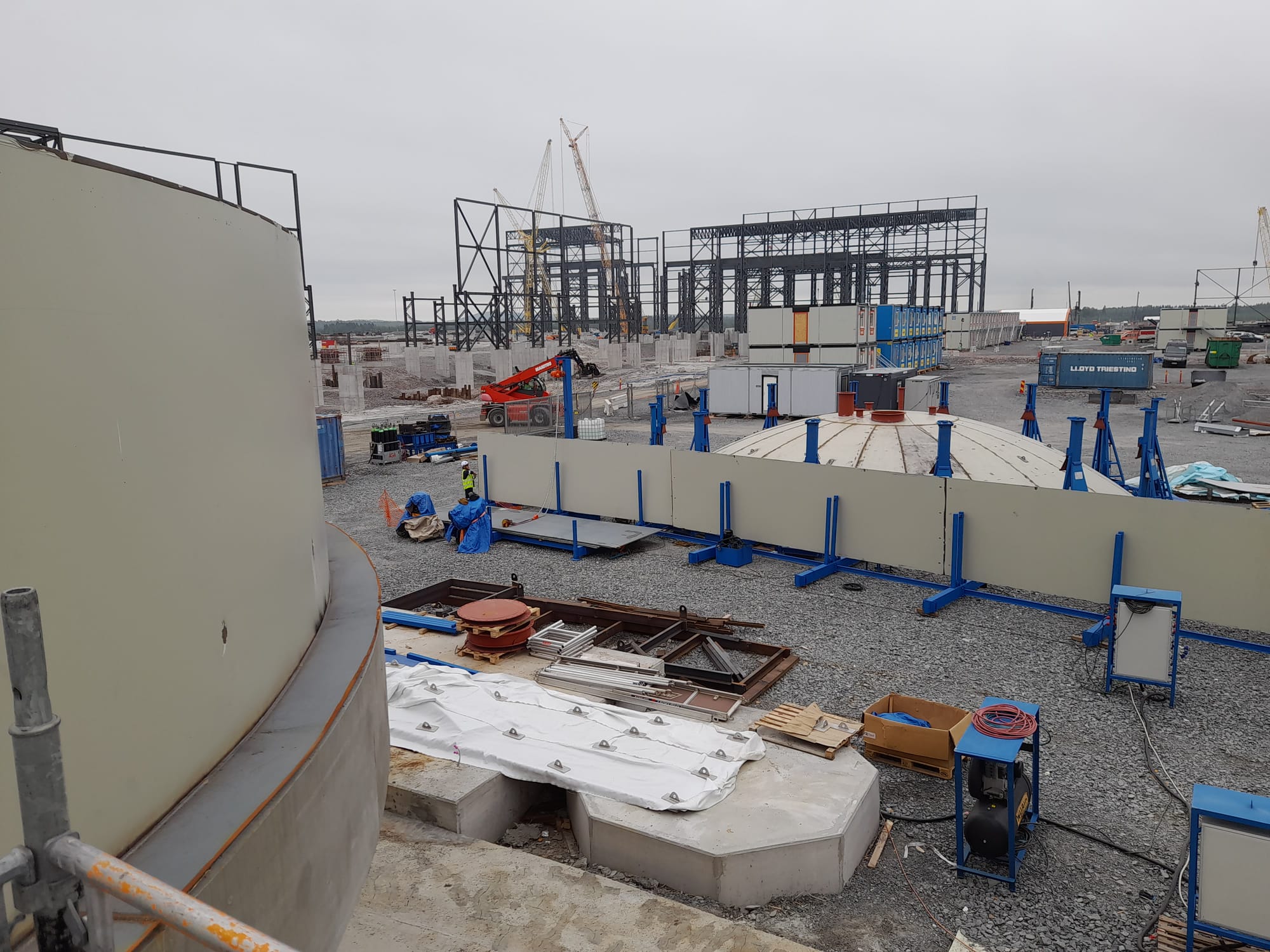

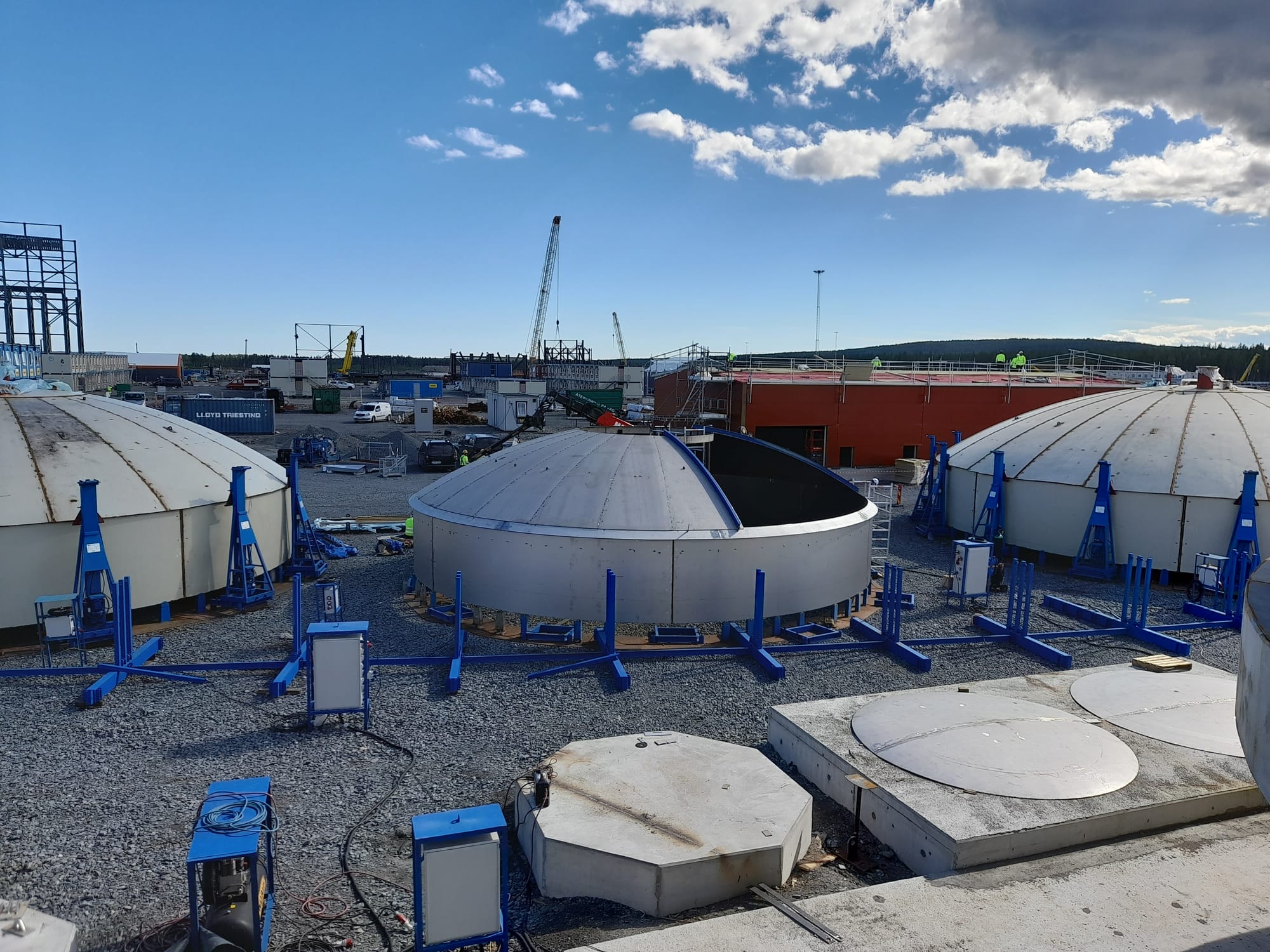

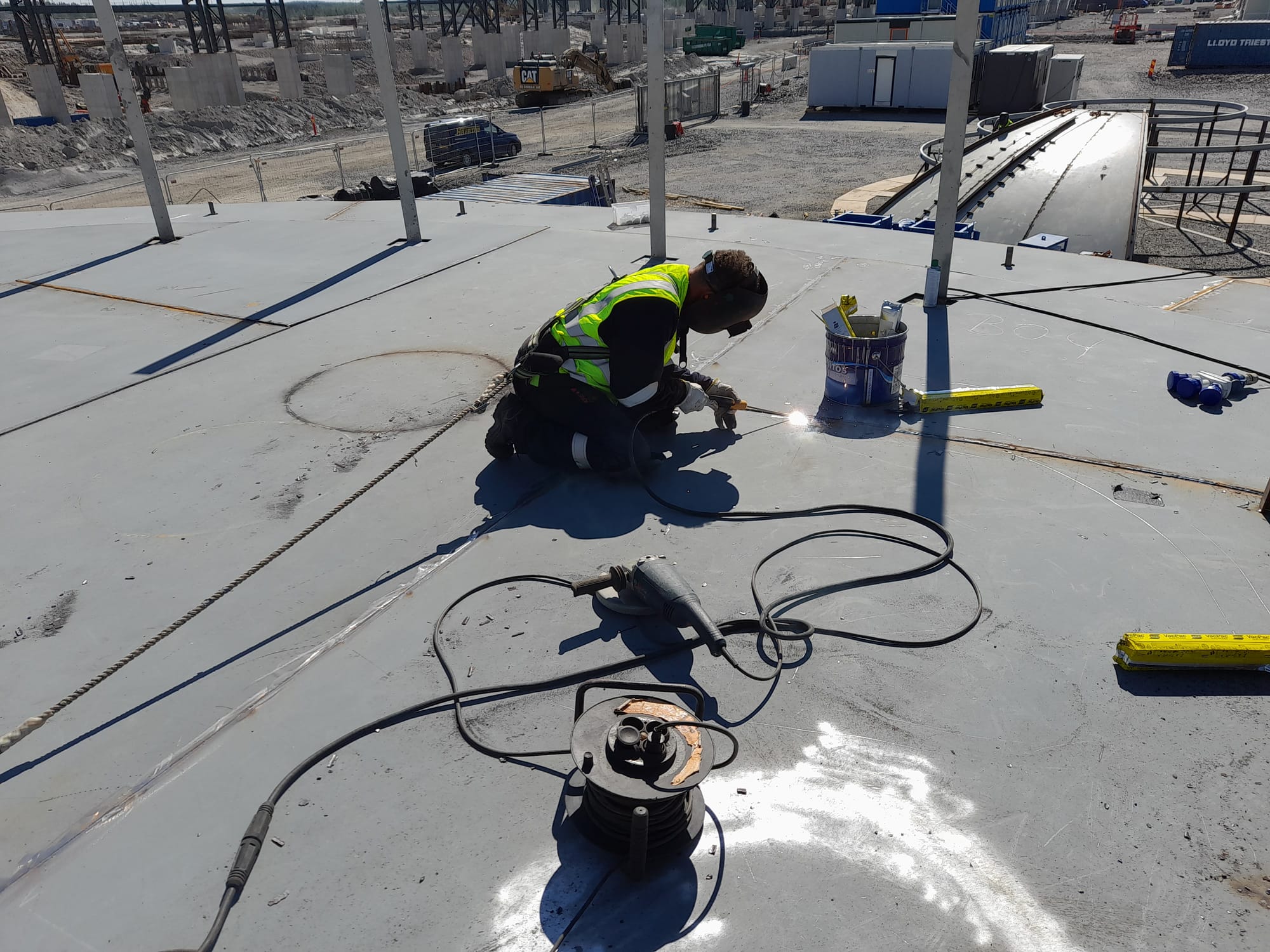

(15/7/24) Started the shell works along with inner tank roofs and temporary cover for Foamglass installation.

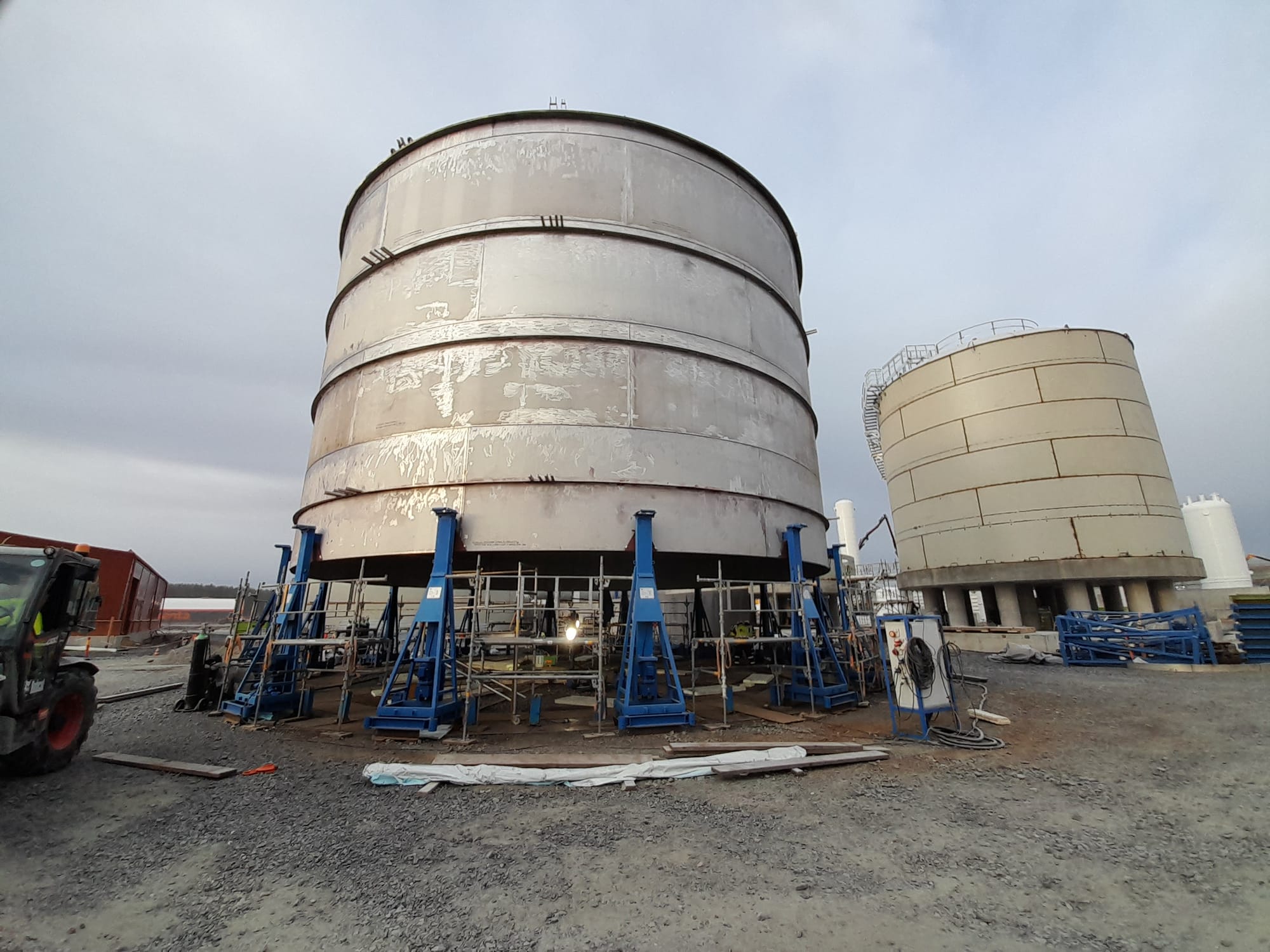

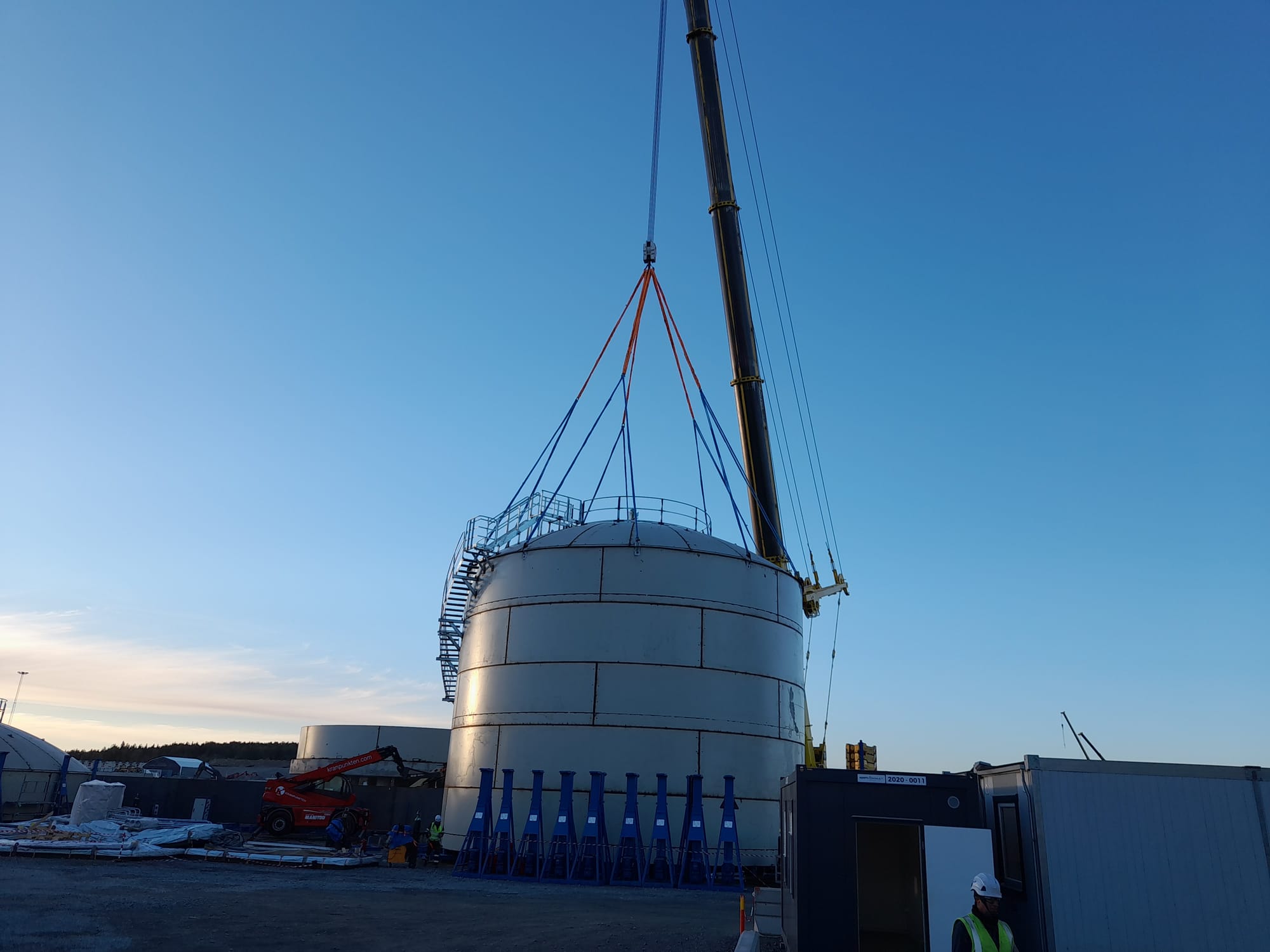

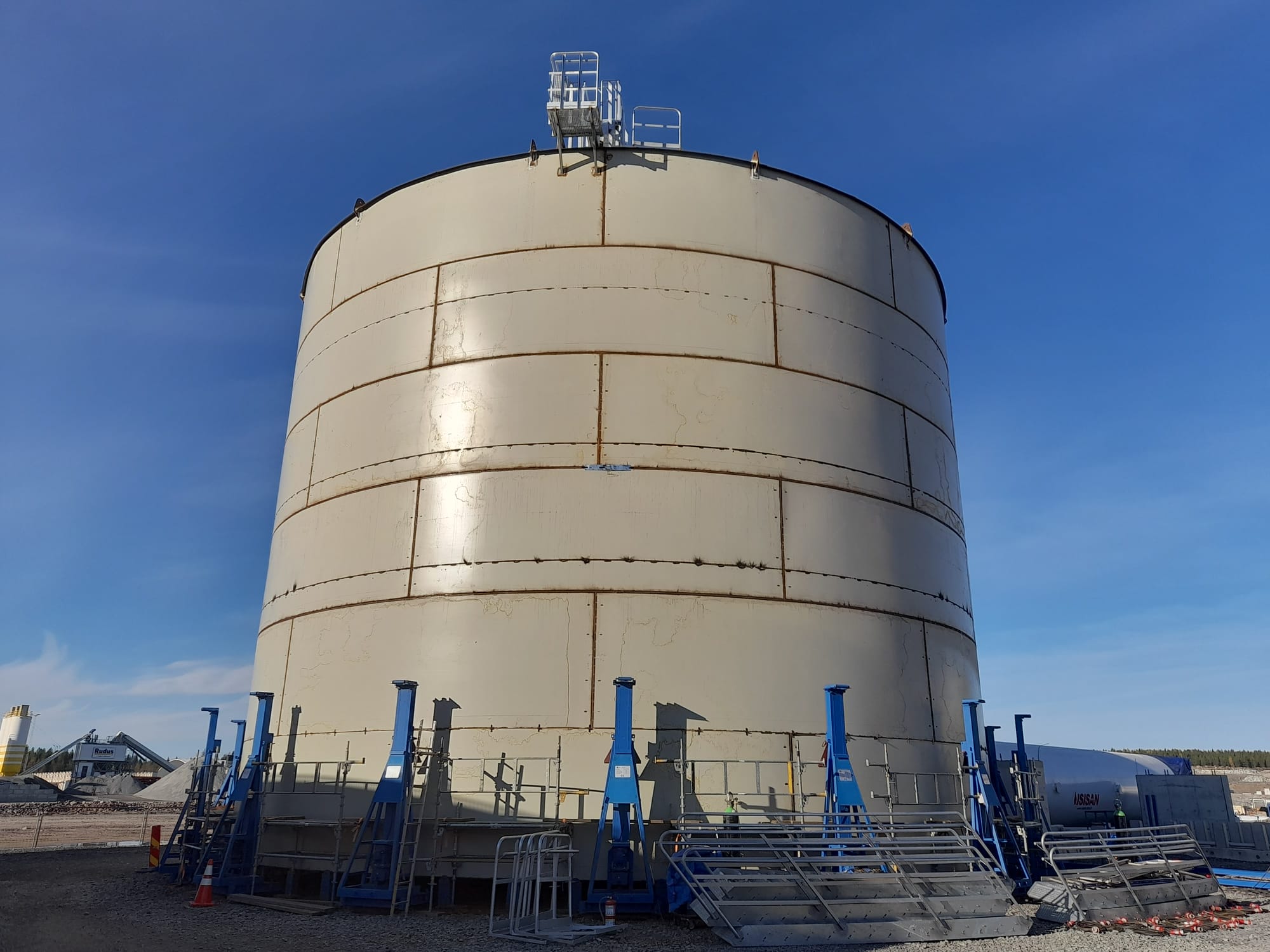

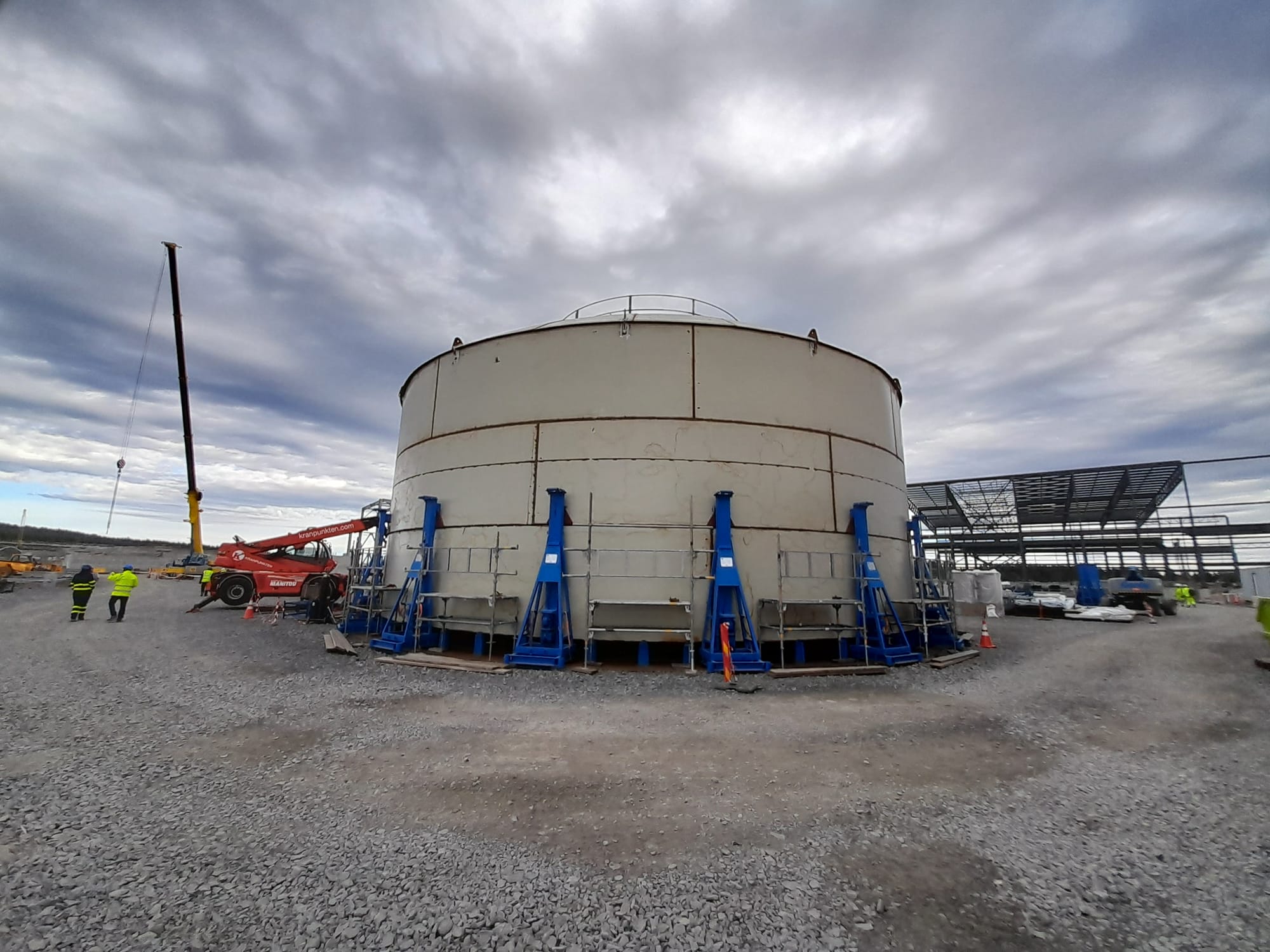

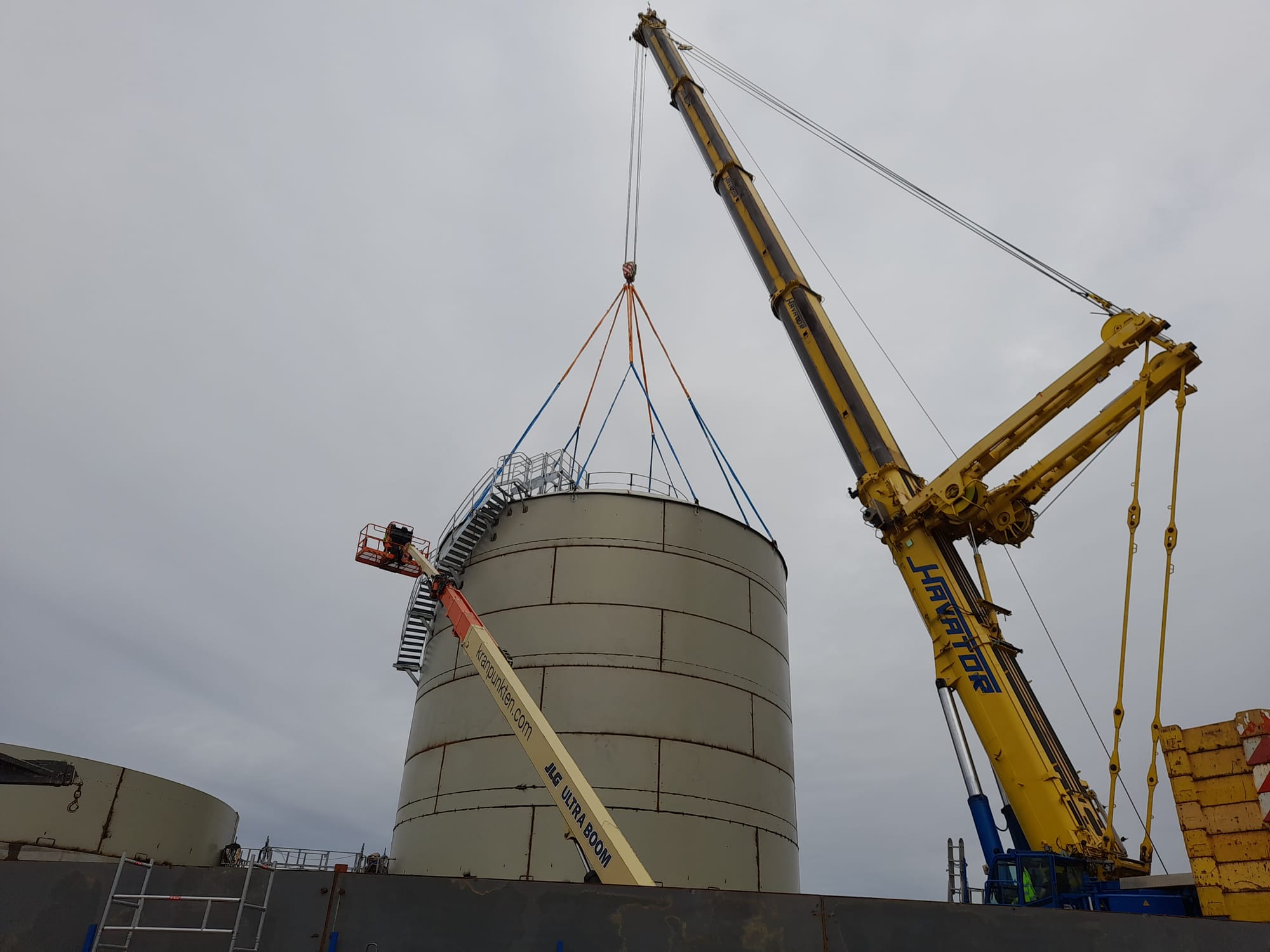

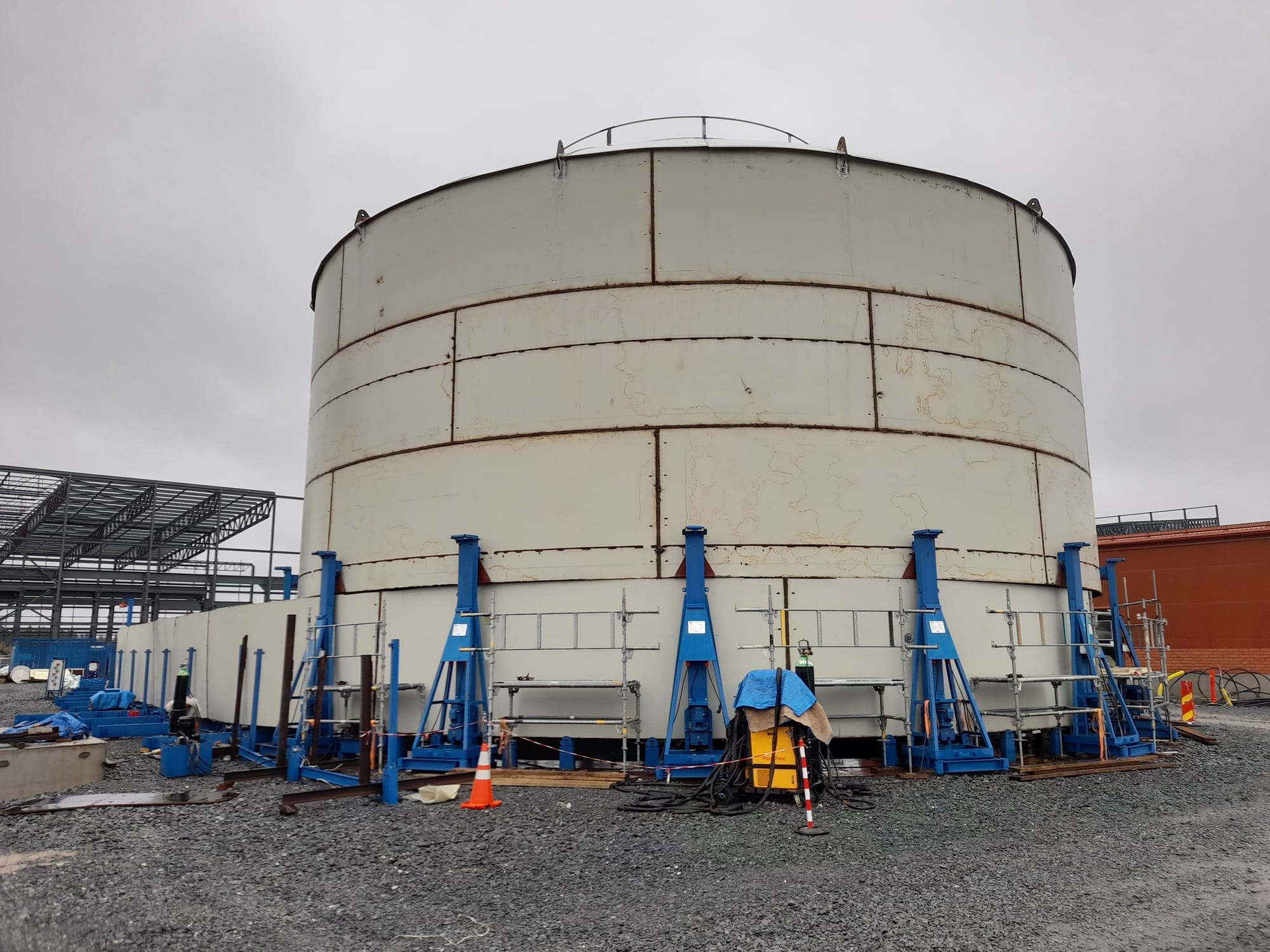

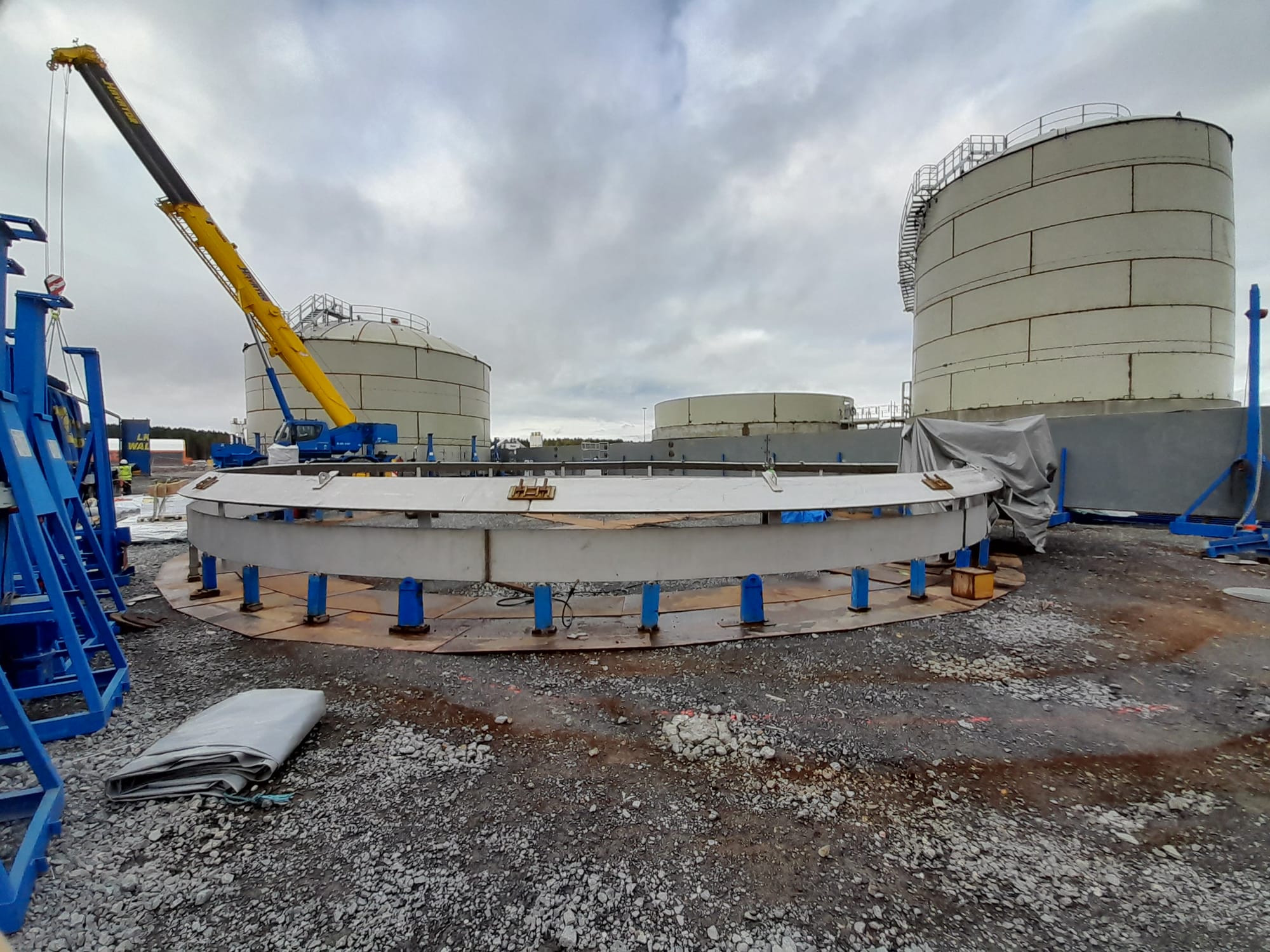

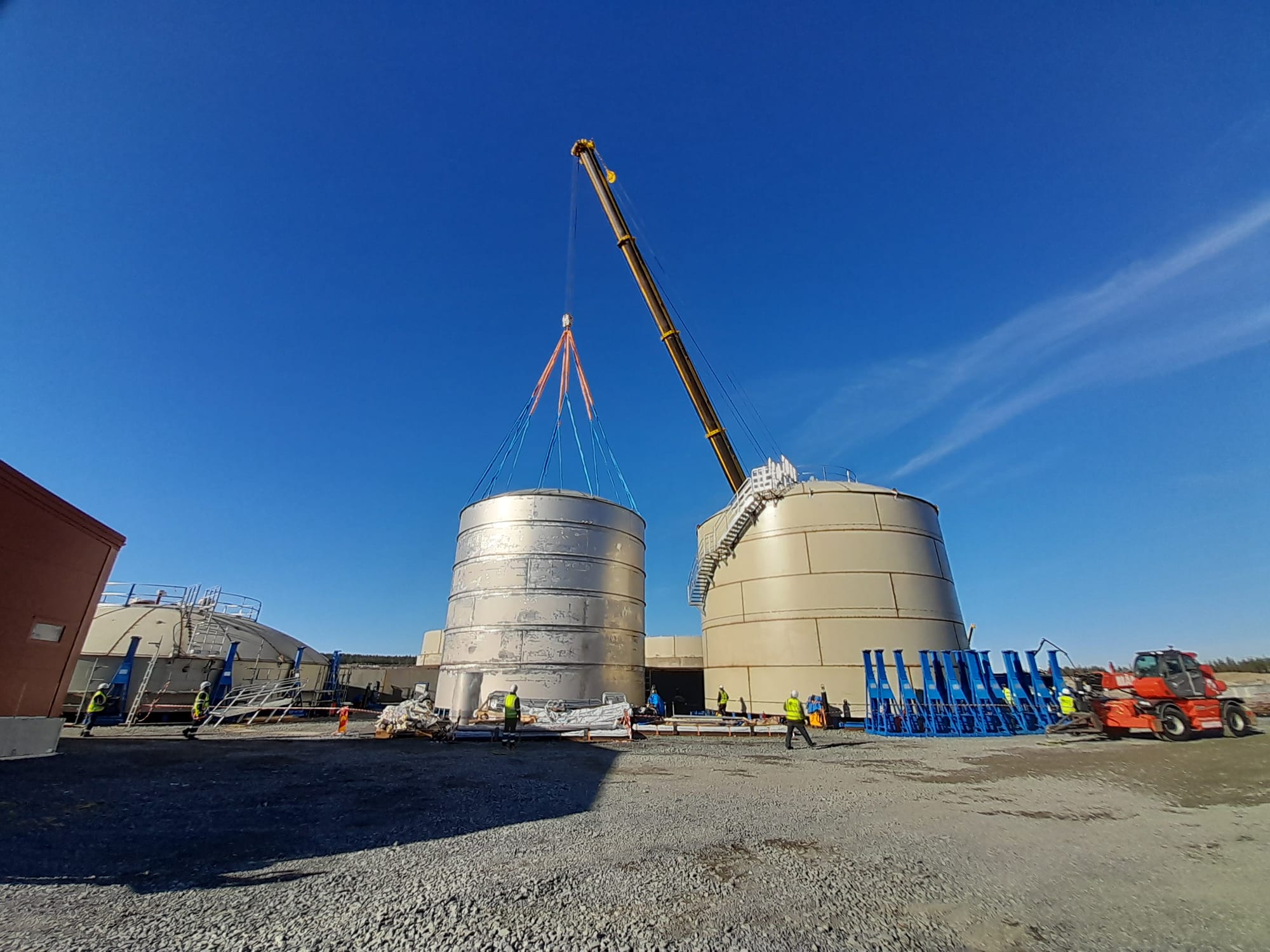

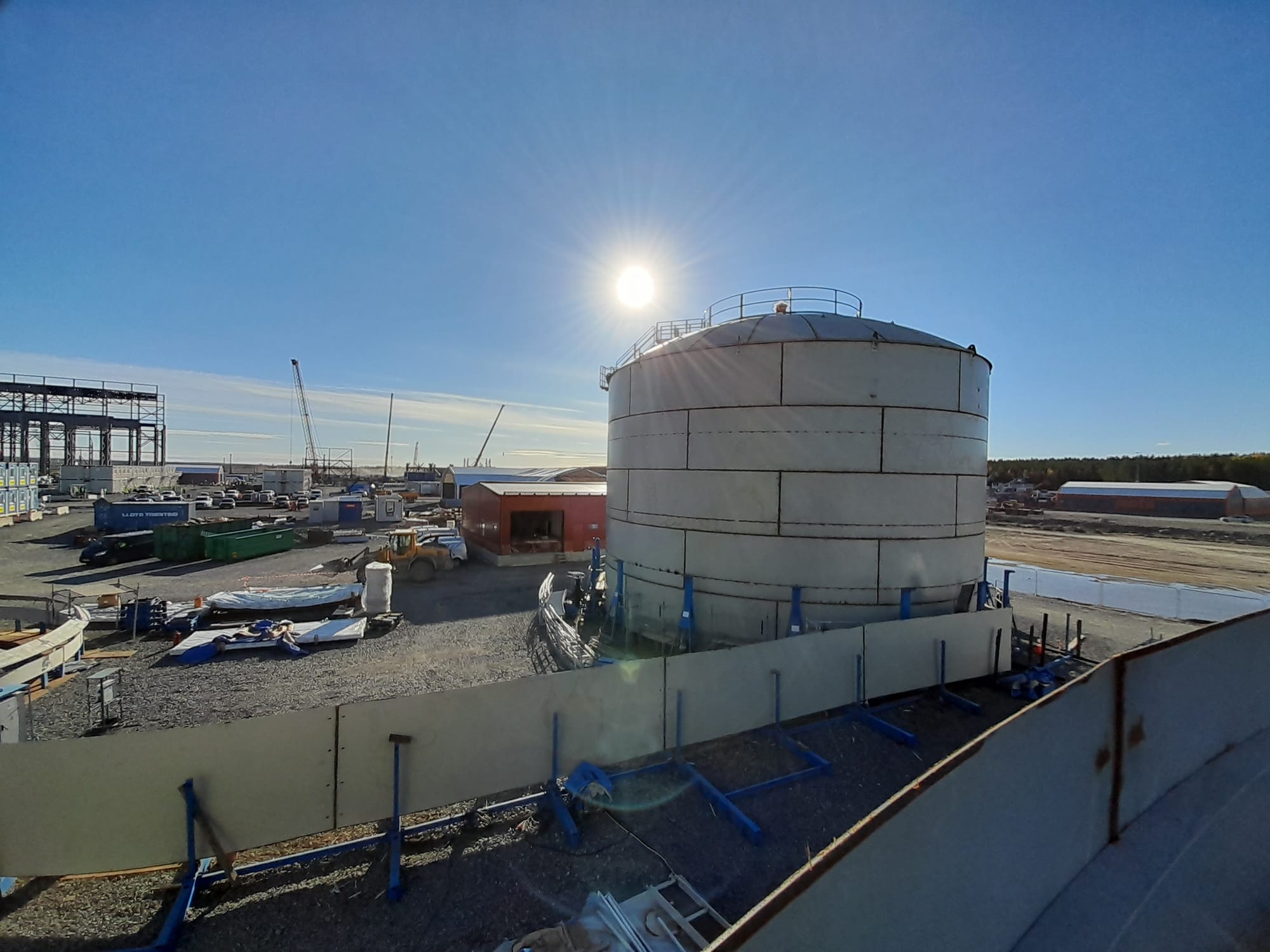

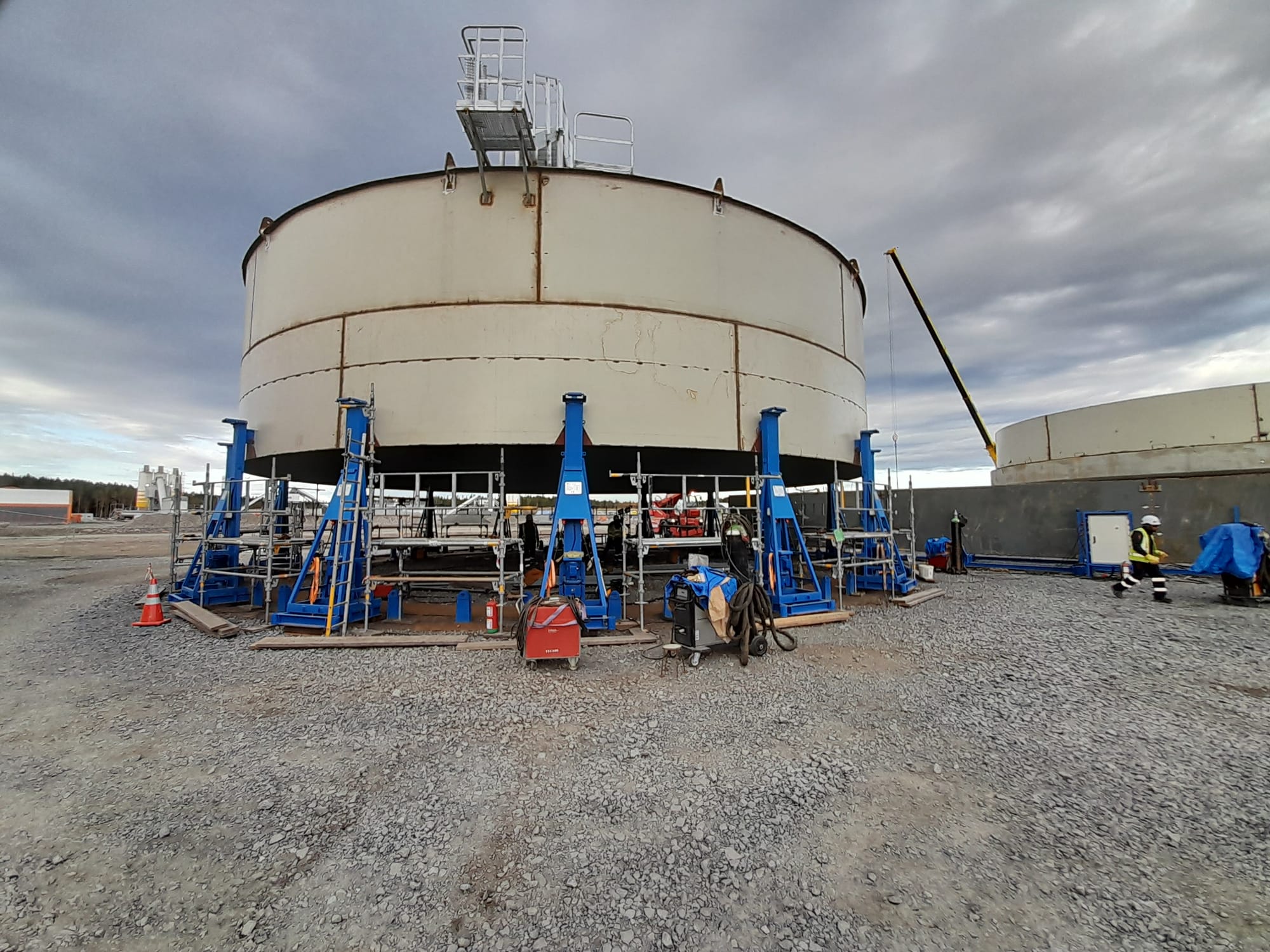

(12/09/2024) First tank shell (LOX) is completed and moved to its final location on the foundation.

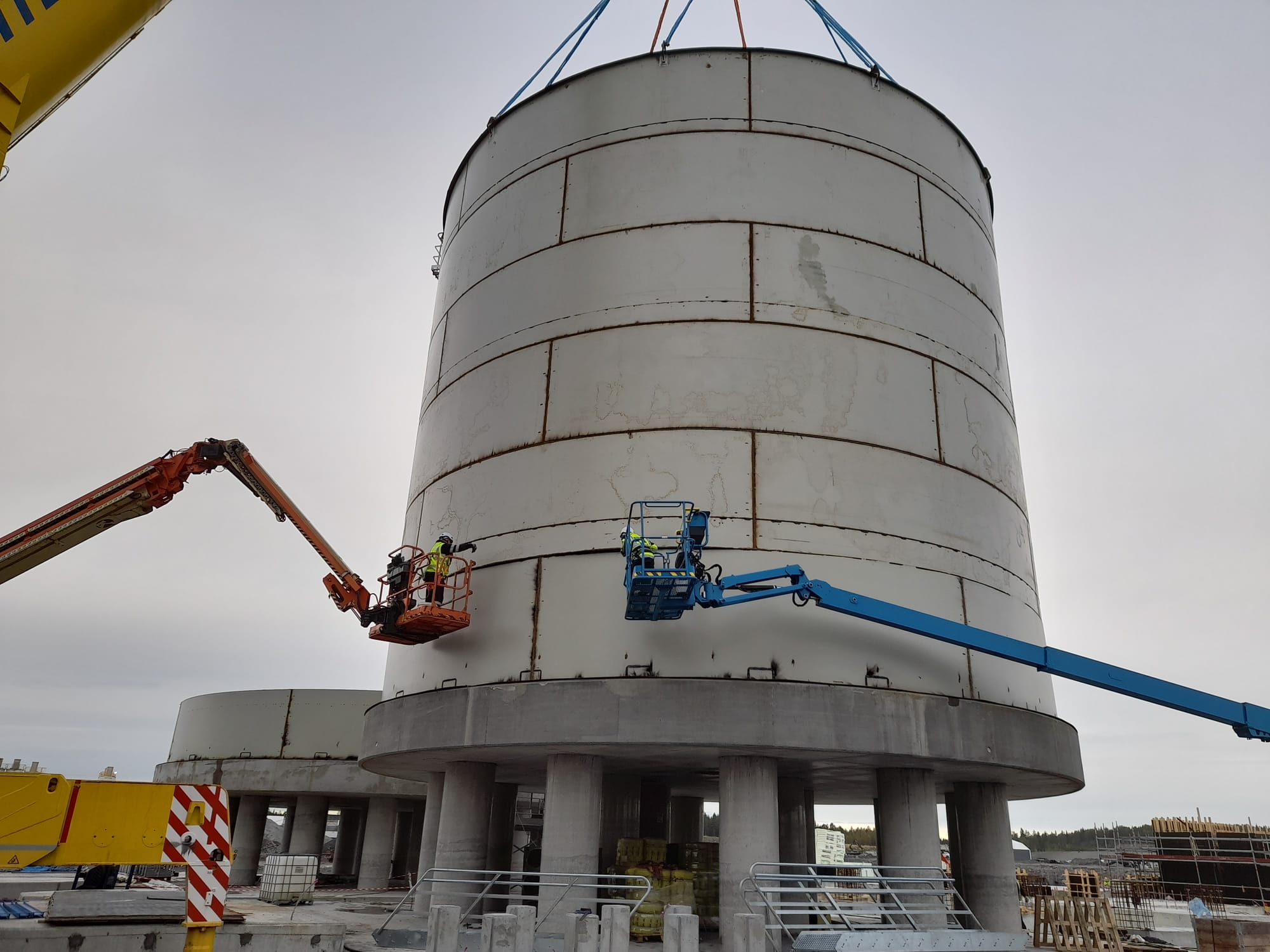

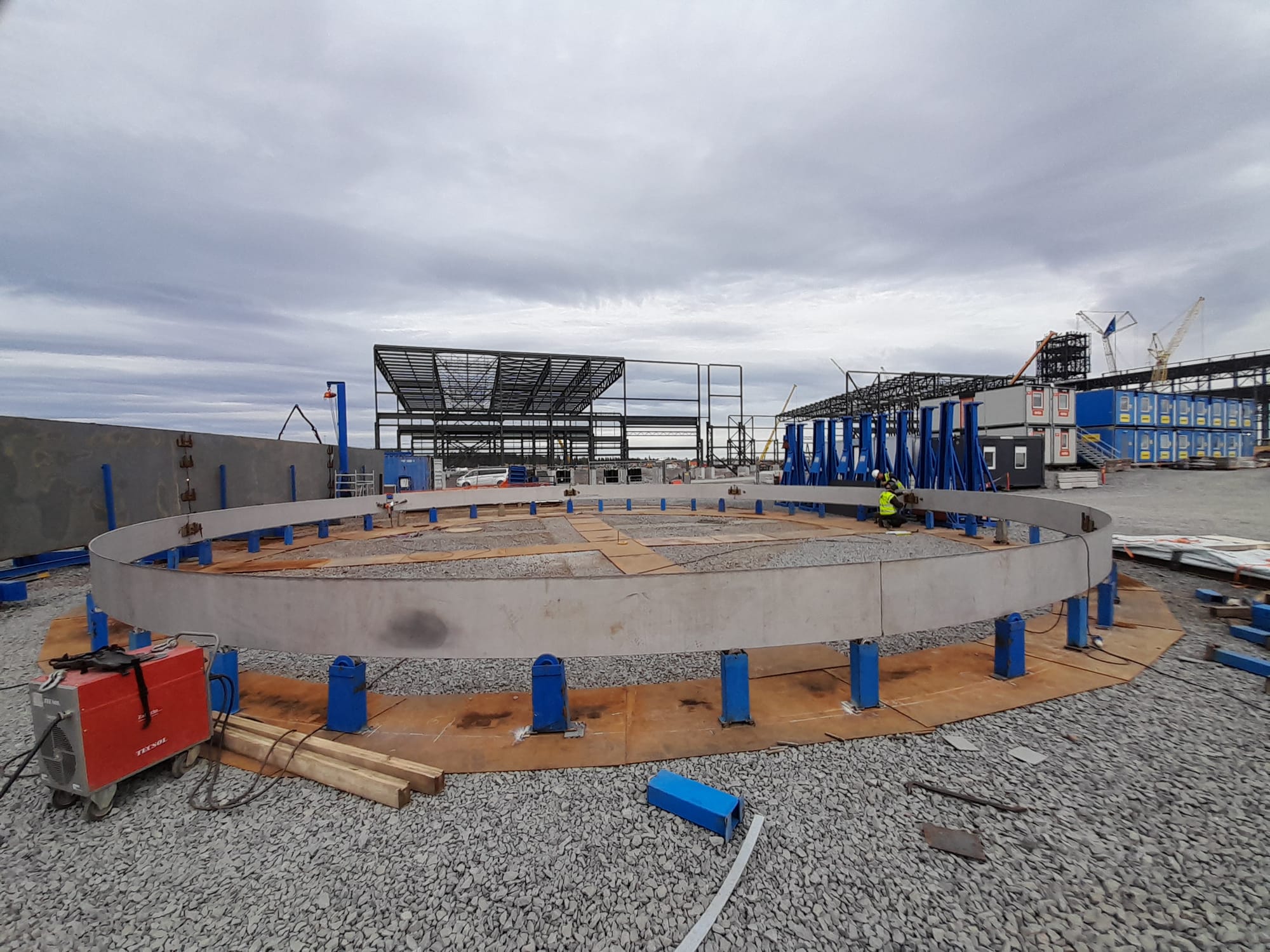

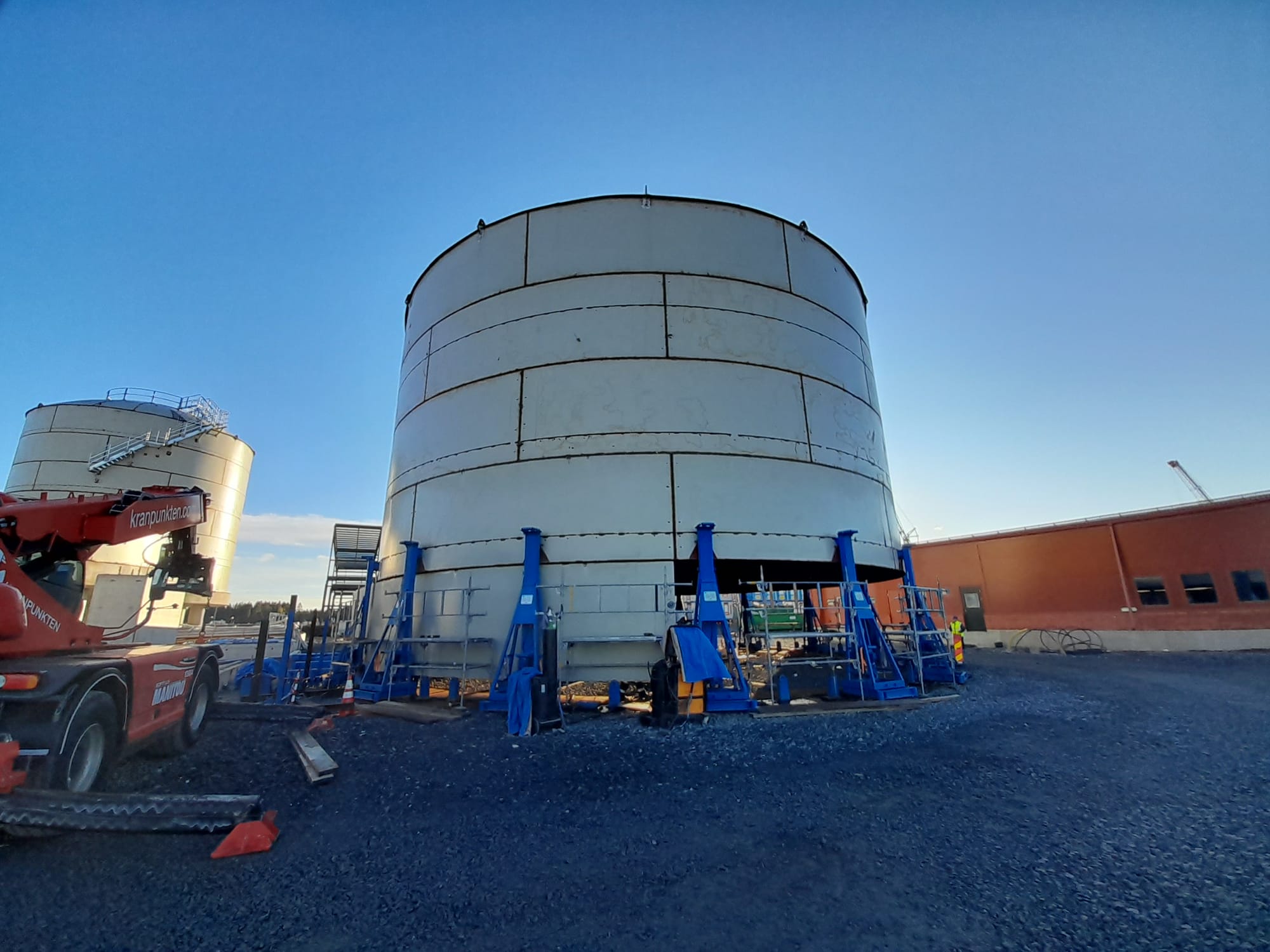

1.- Inox tank moved to the foundation


2.- CS tank moved to final position covering the Inox part.

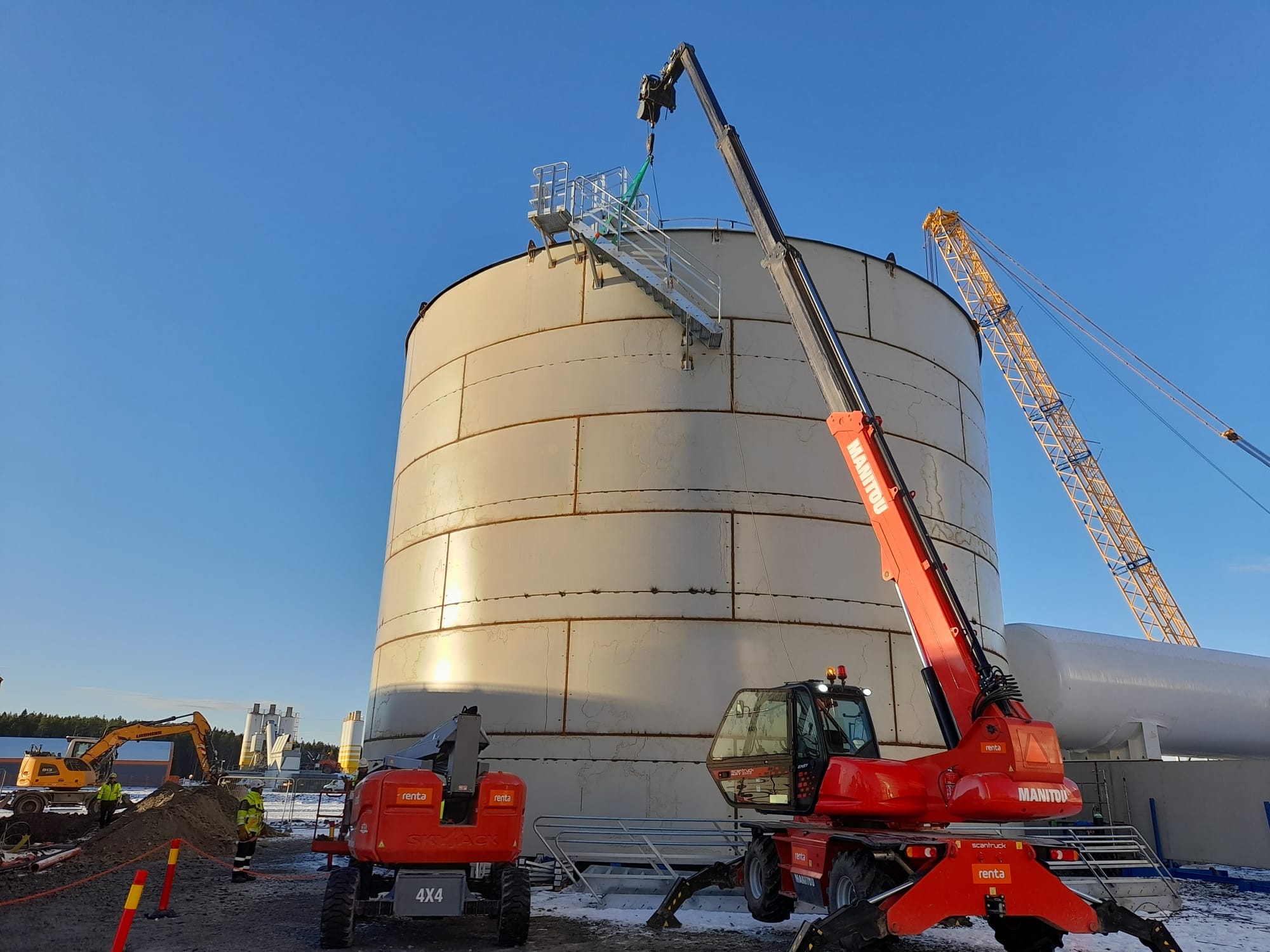

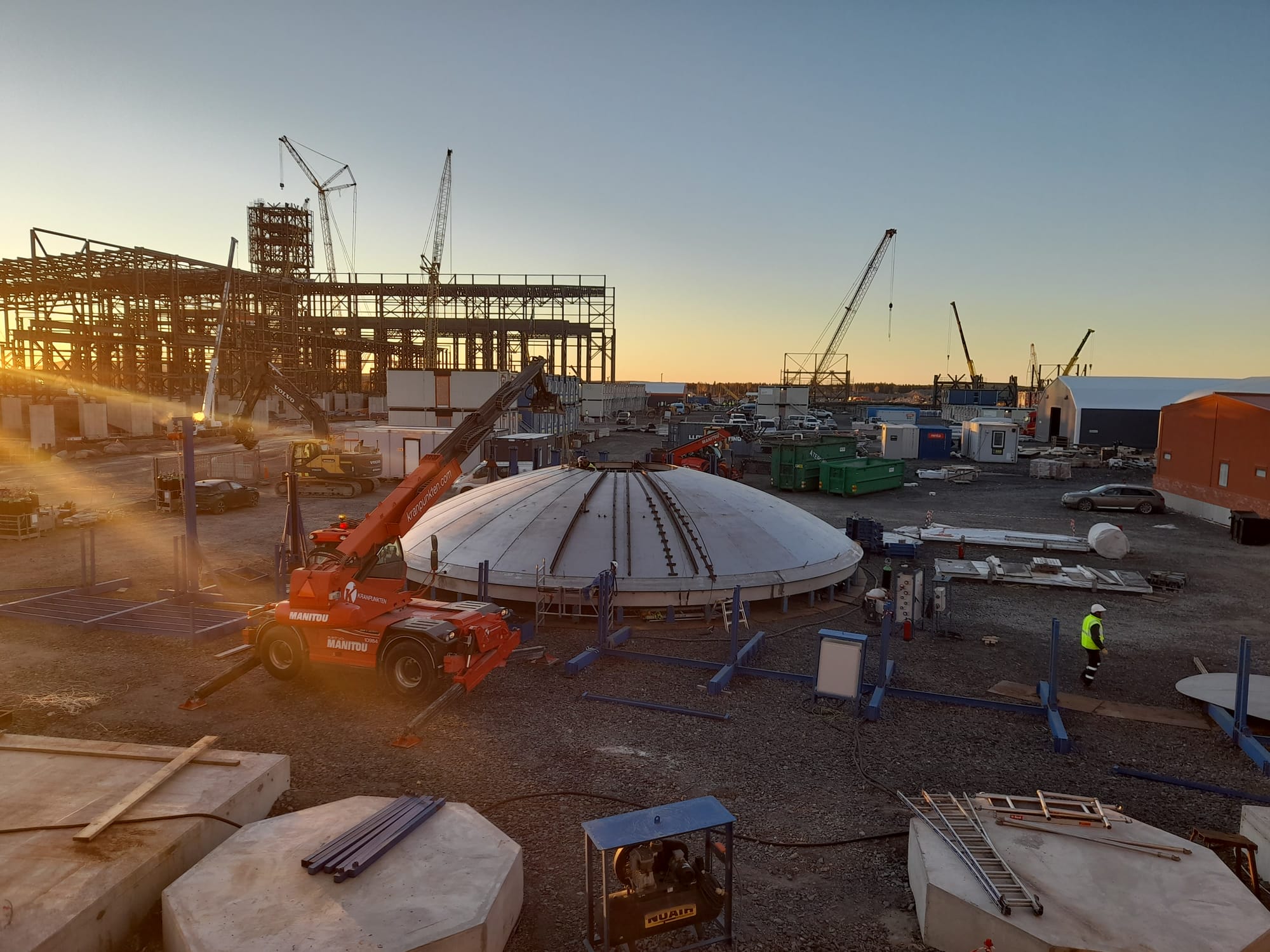

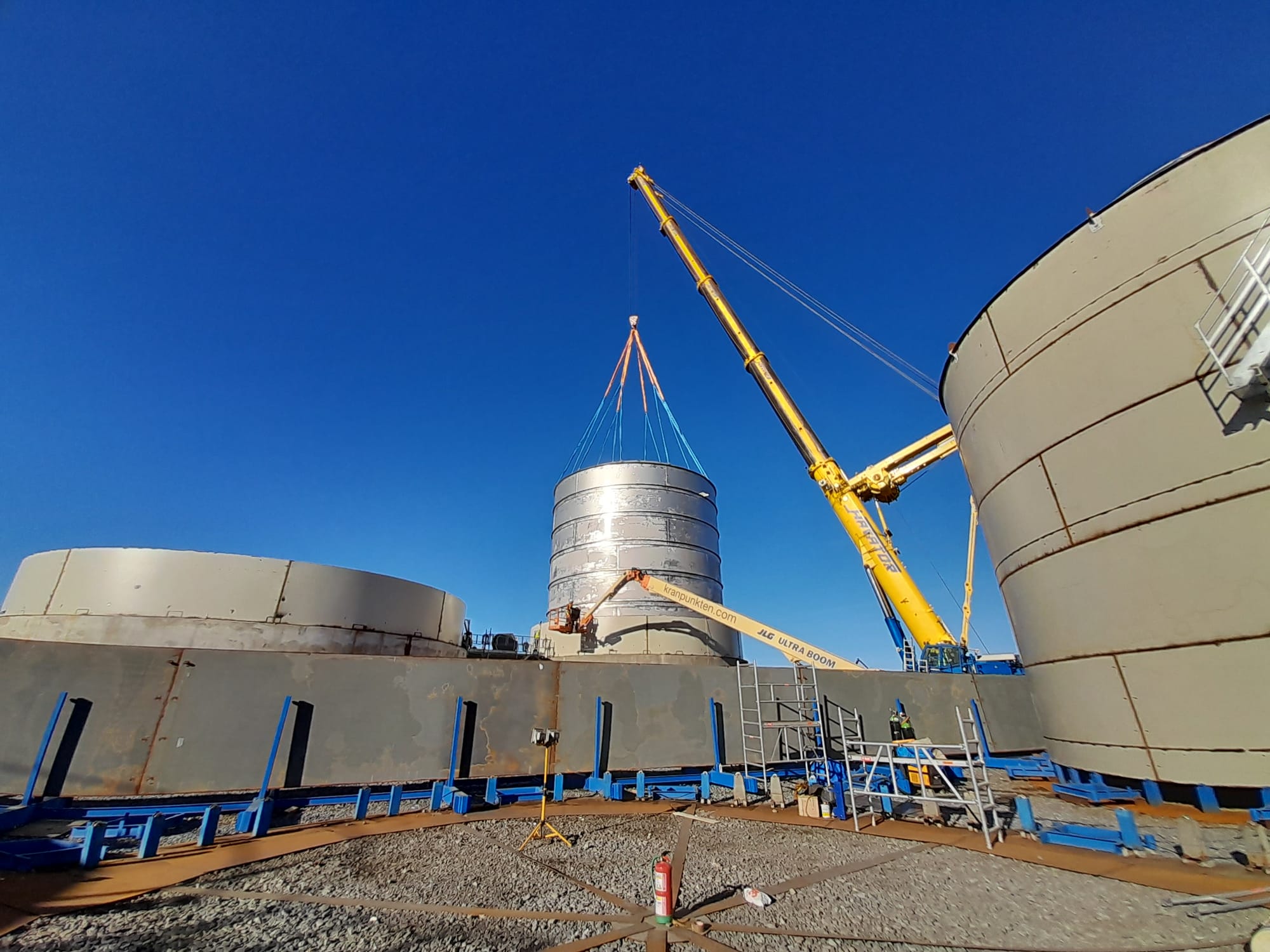

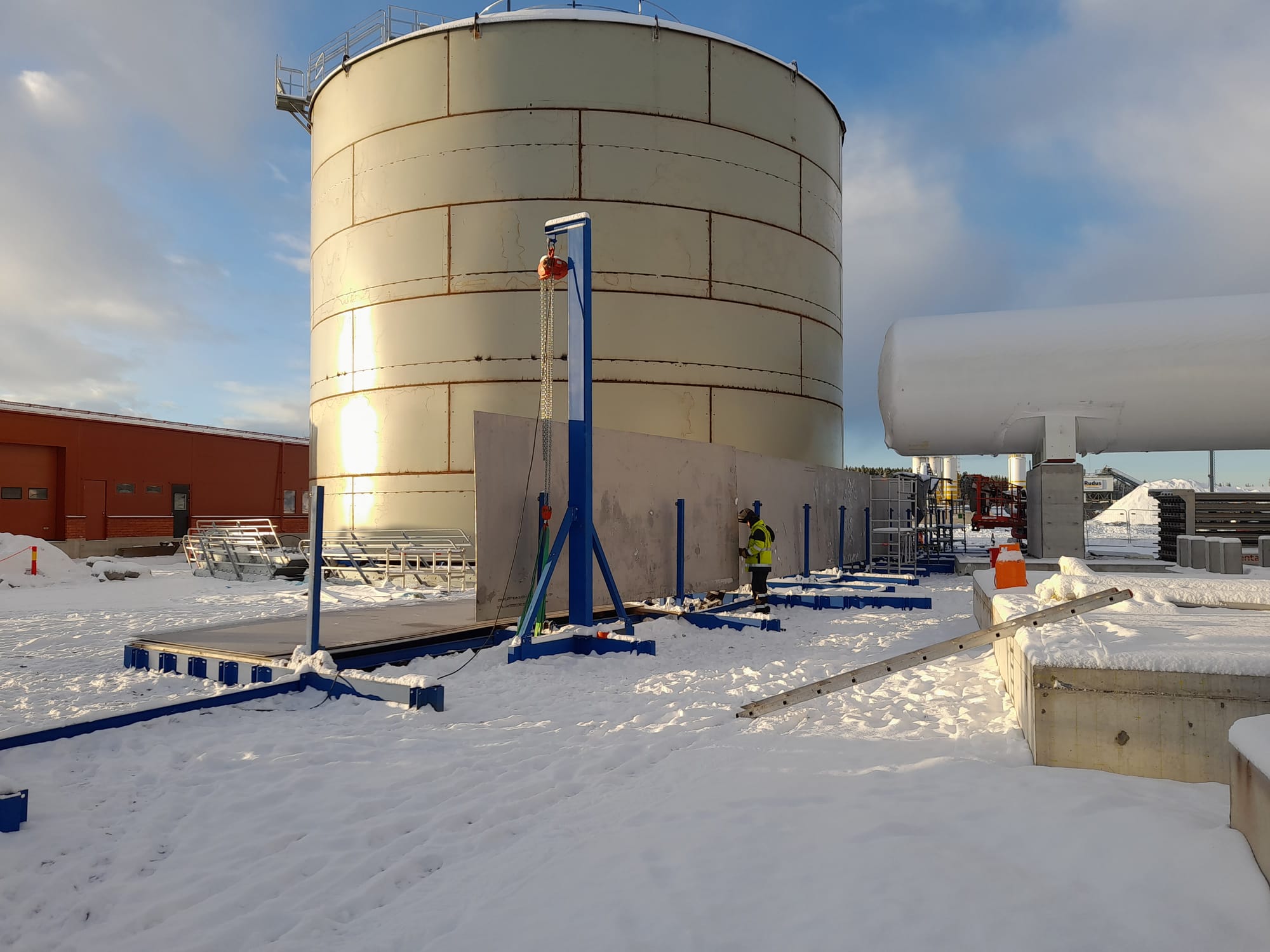

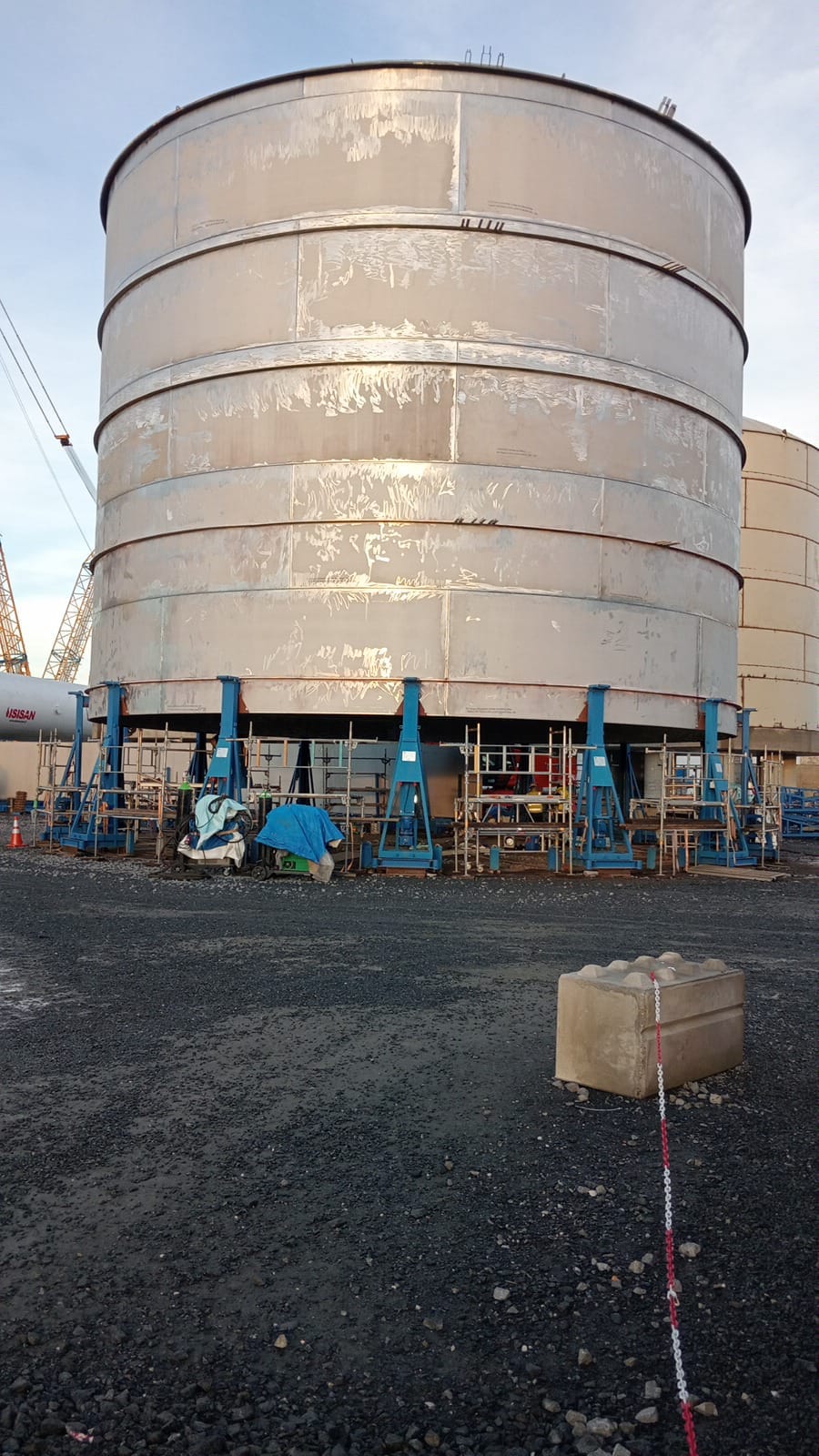

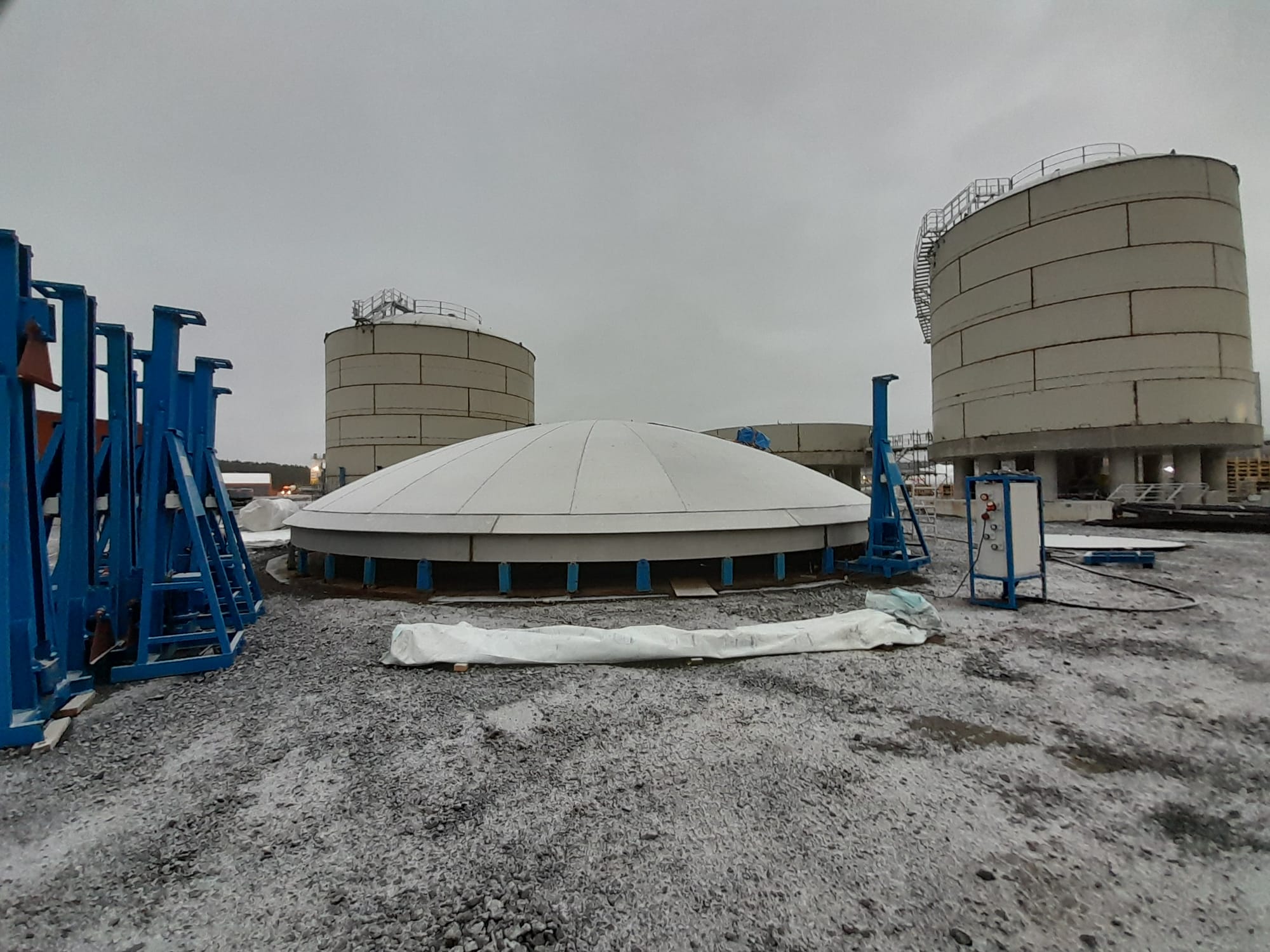

(15/09/2024-10/10/2024) Start LIN Inox tank assembly

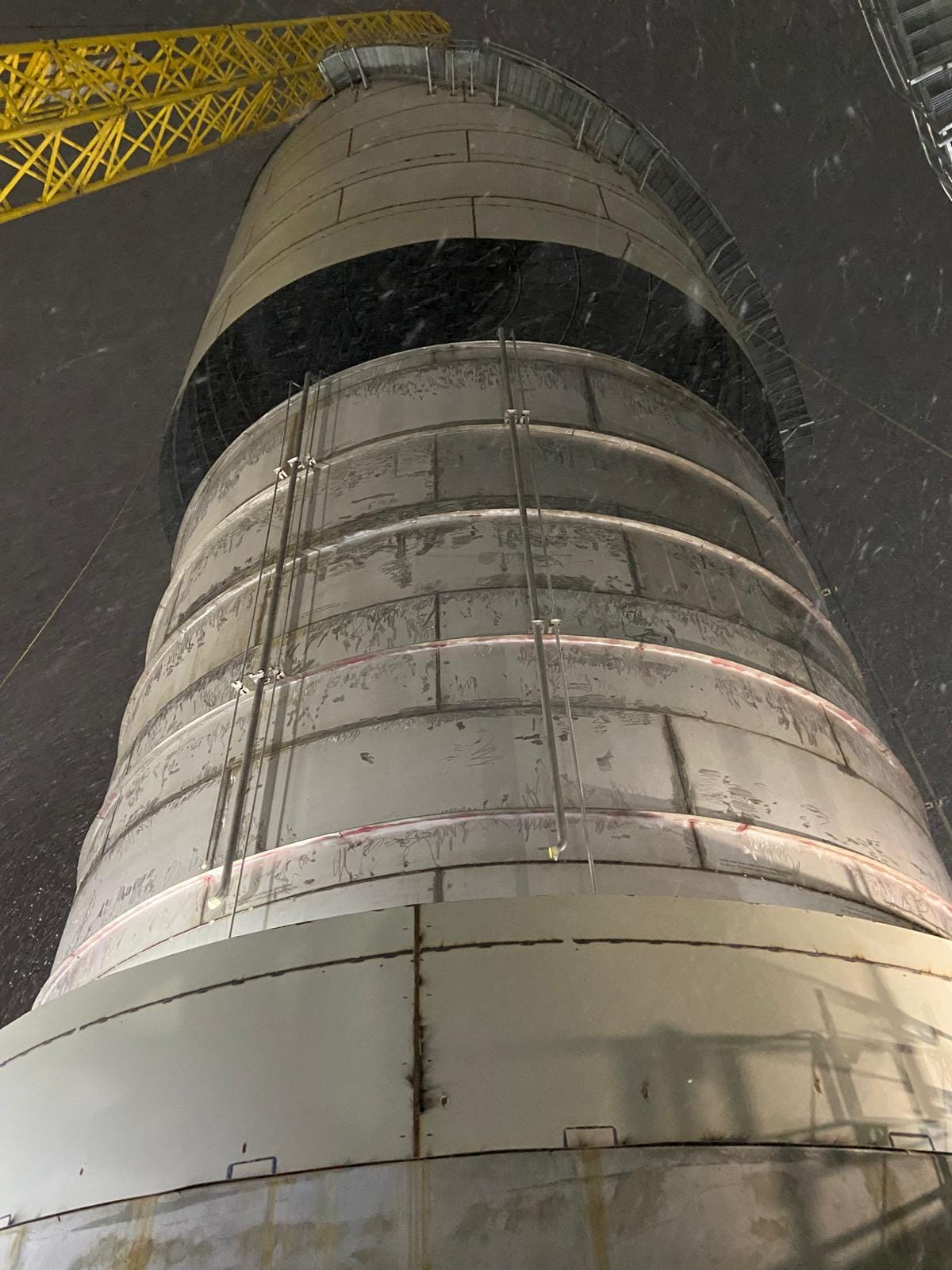

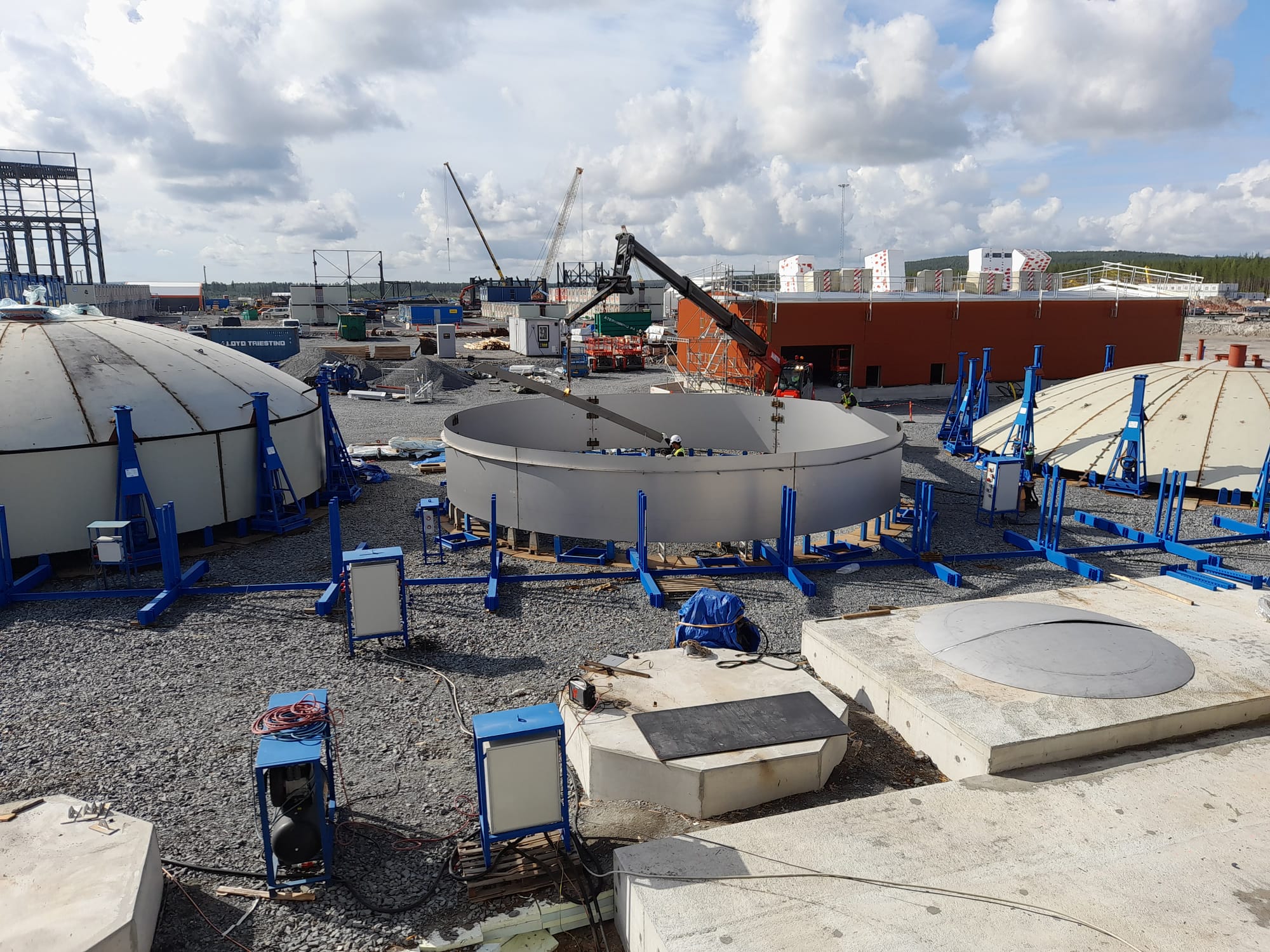

CS LIN shell tank progress

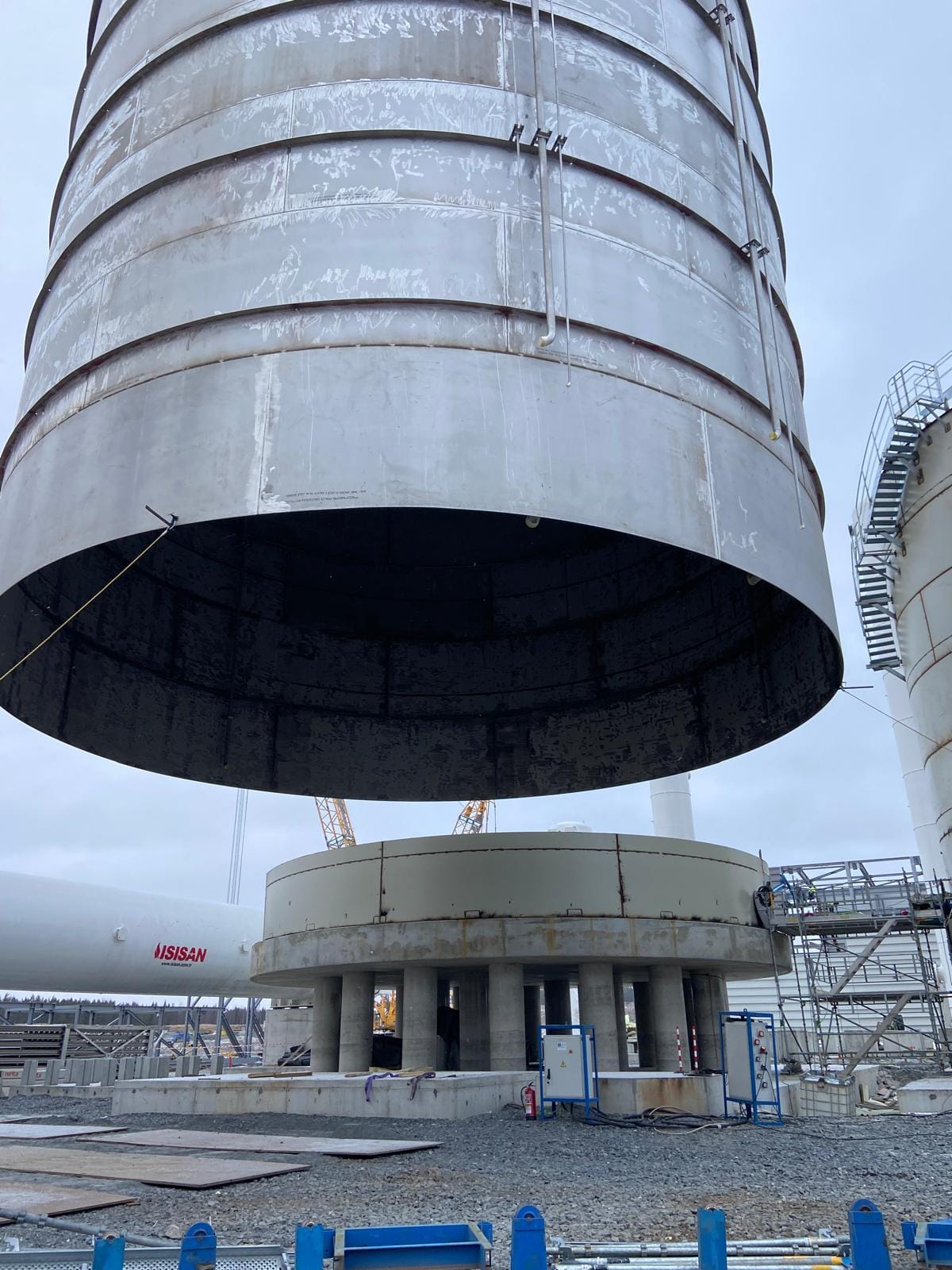

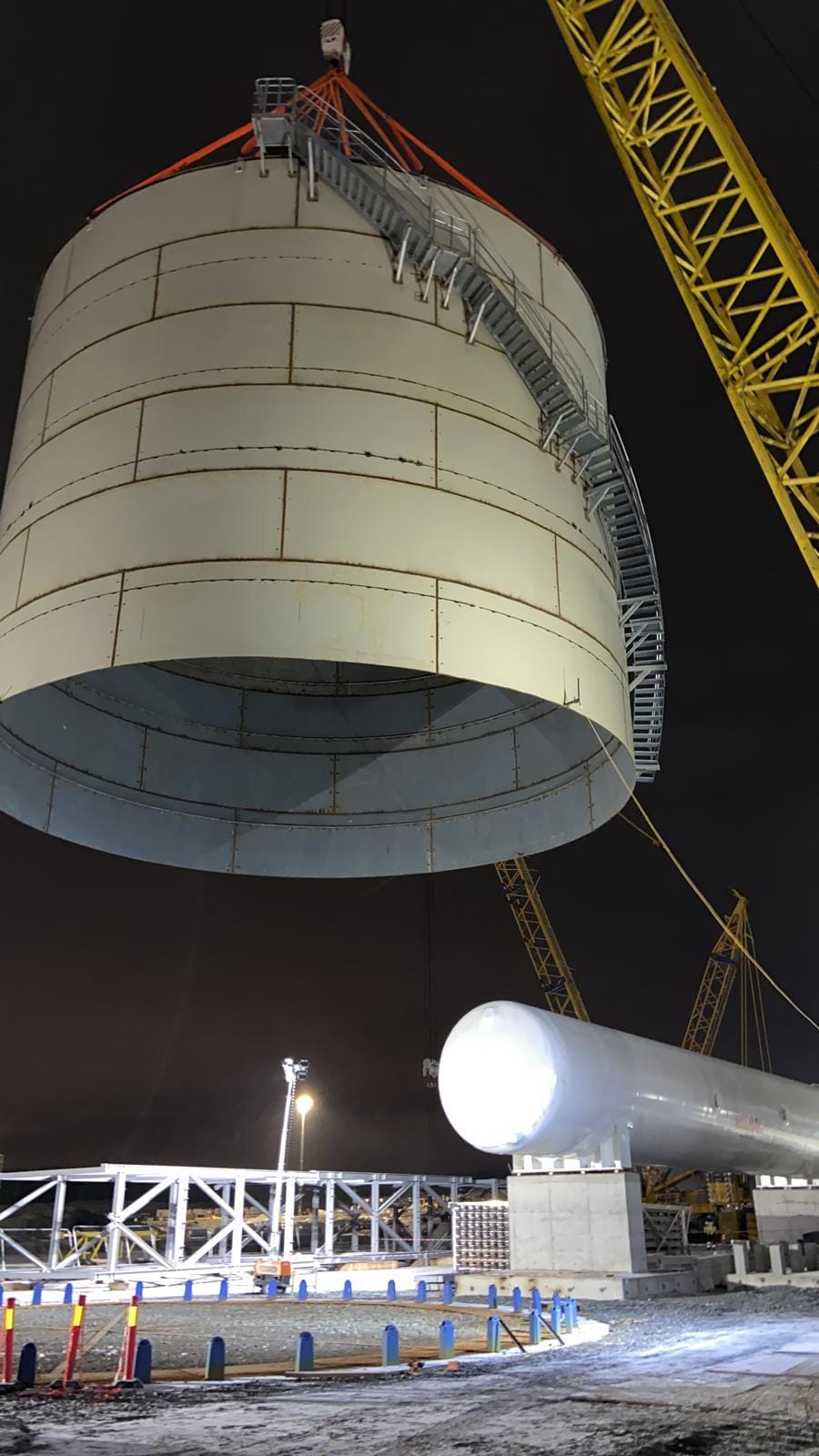

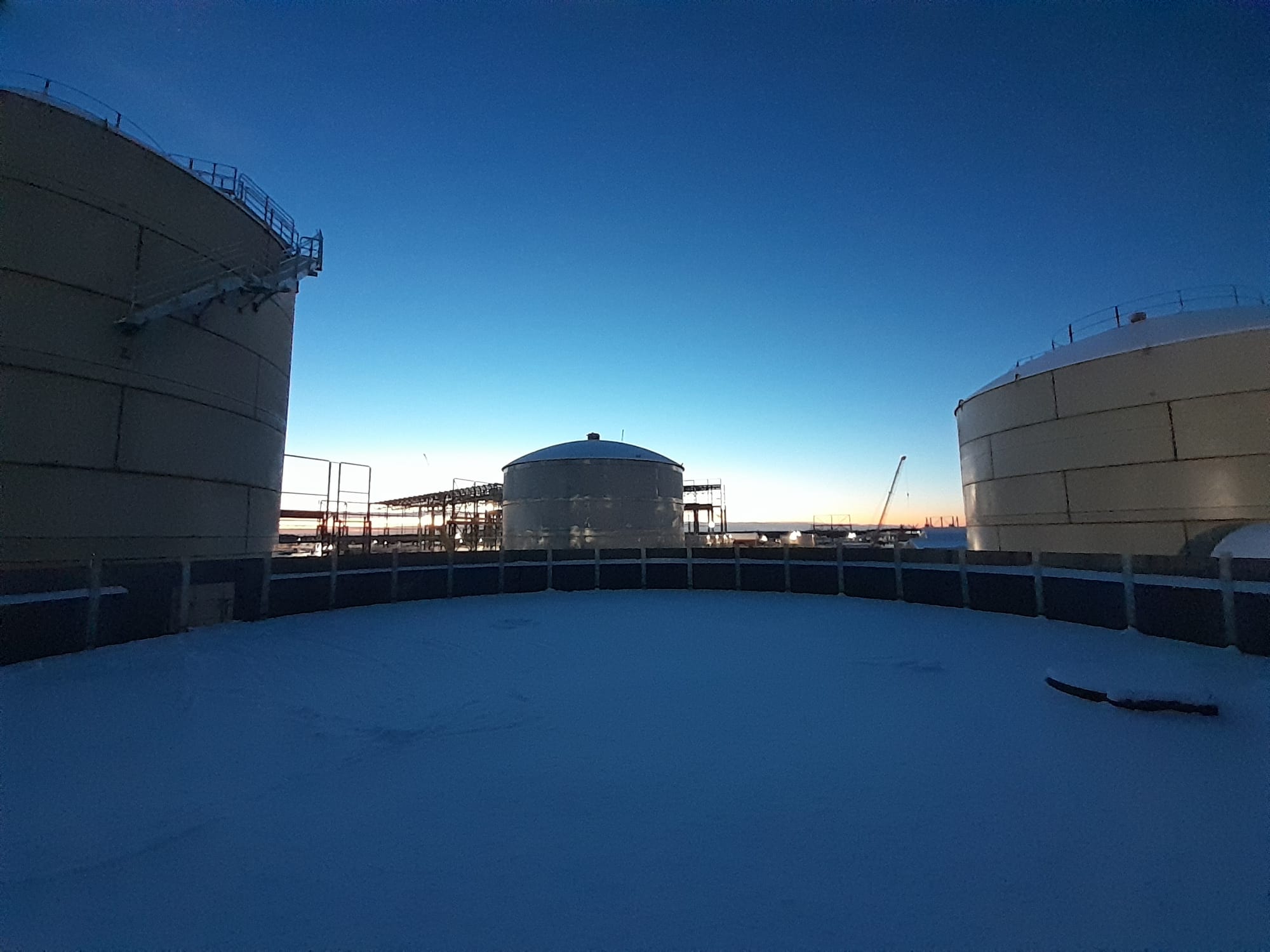

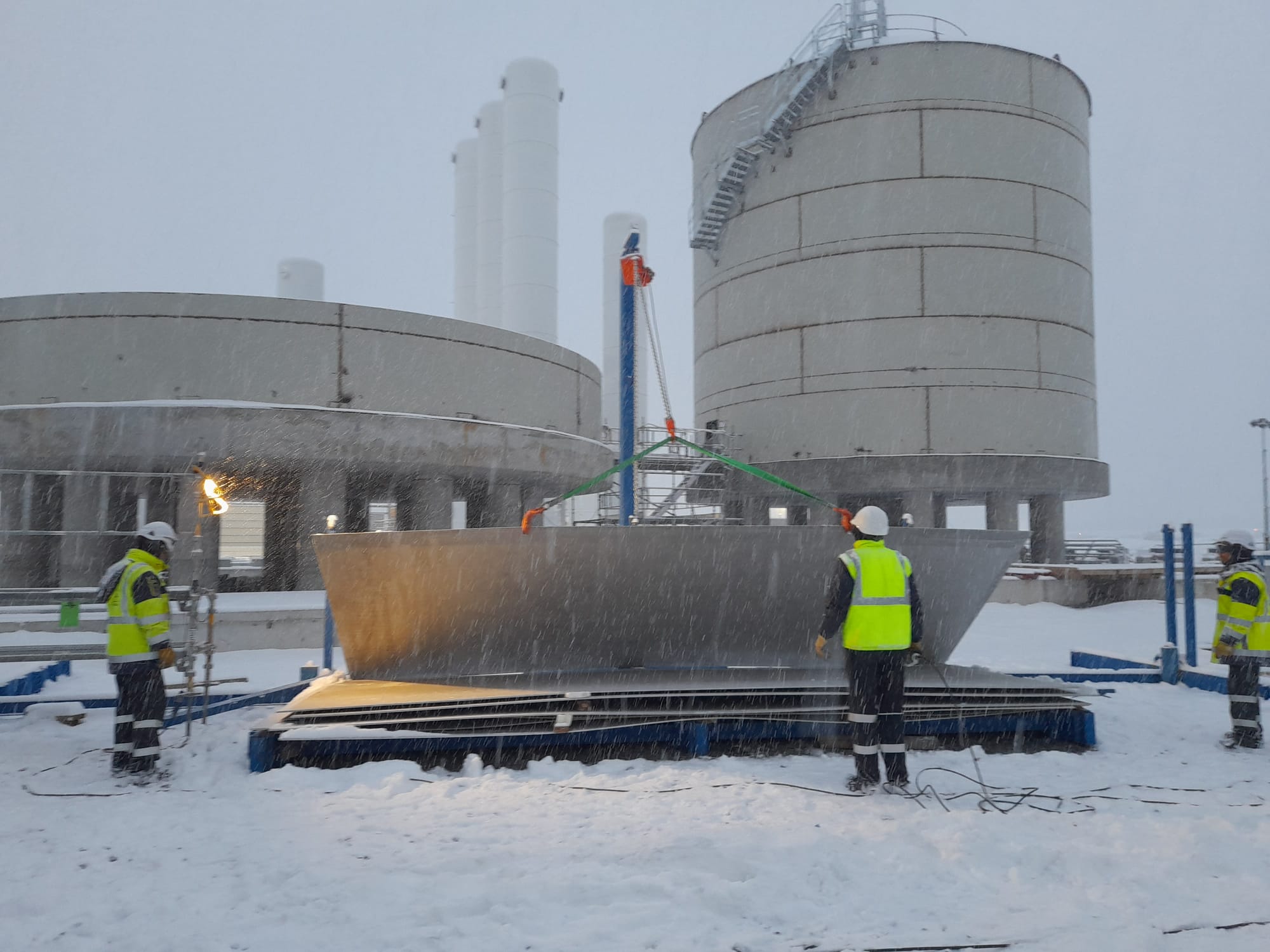

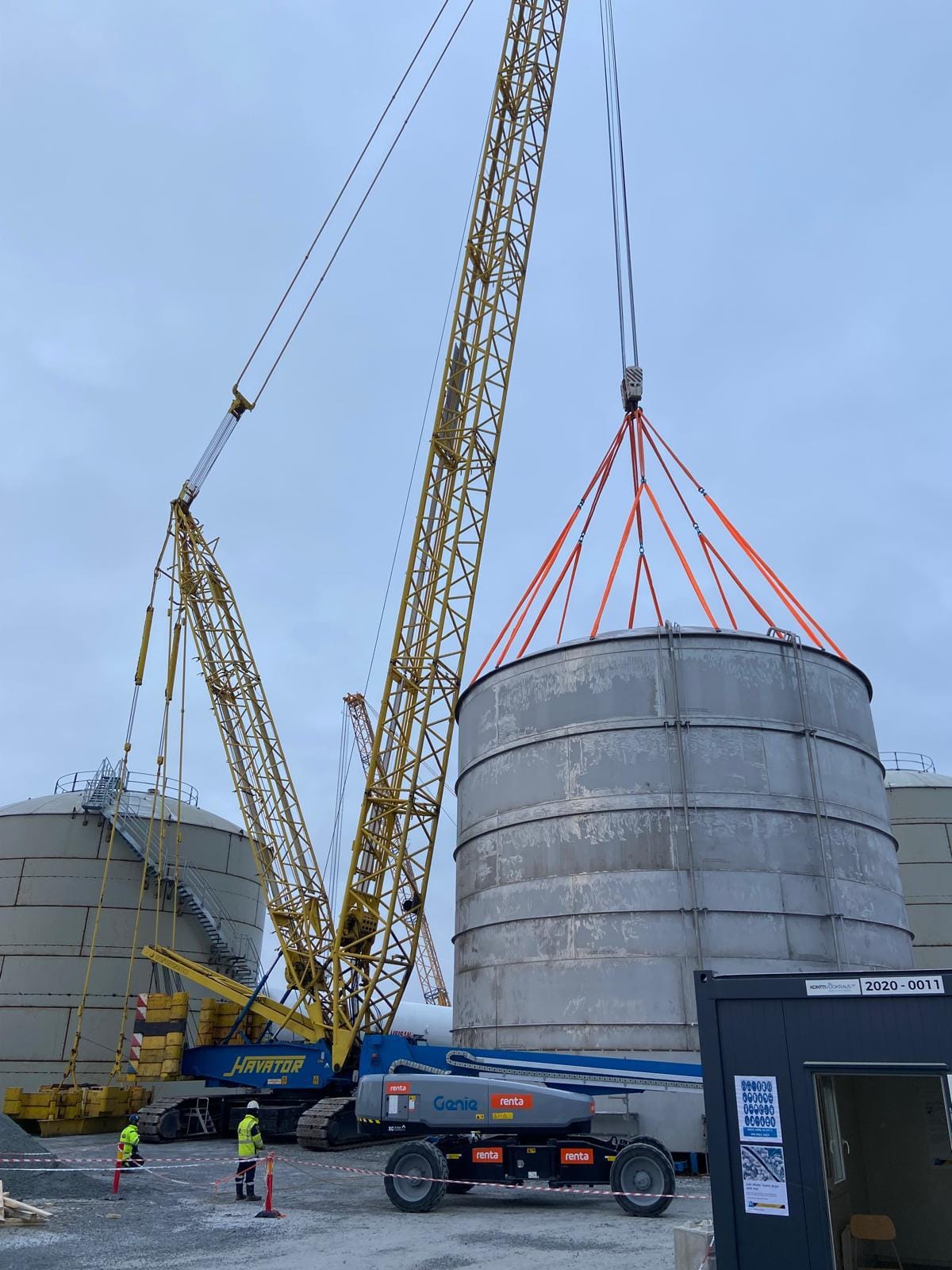

(04/12/24) We finished the lifting of LIN tank that was planned for May-25 which is a huge improvement in our schedule. We demobilize for few months until weather conditions are suitable for welding.
